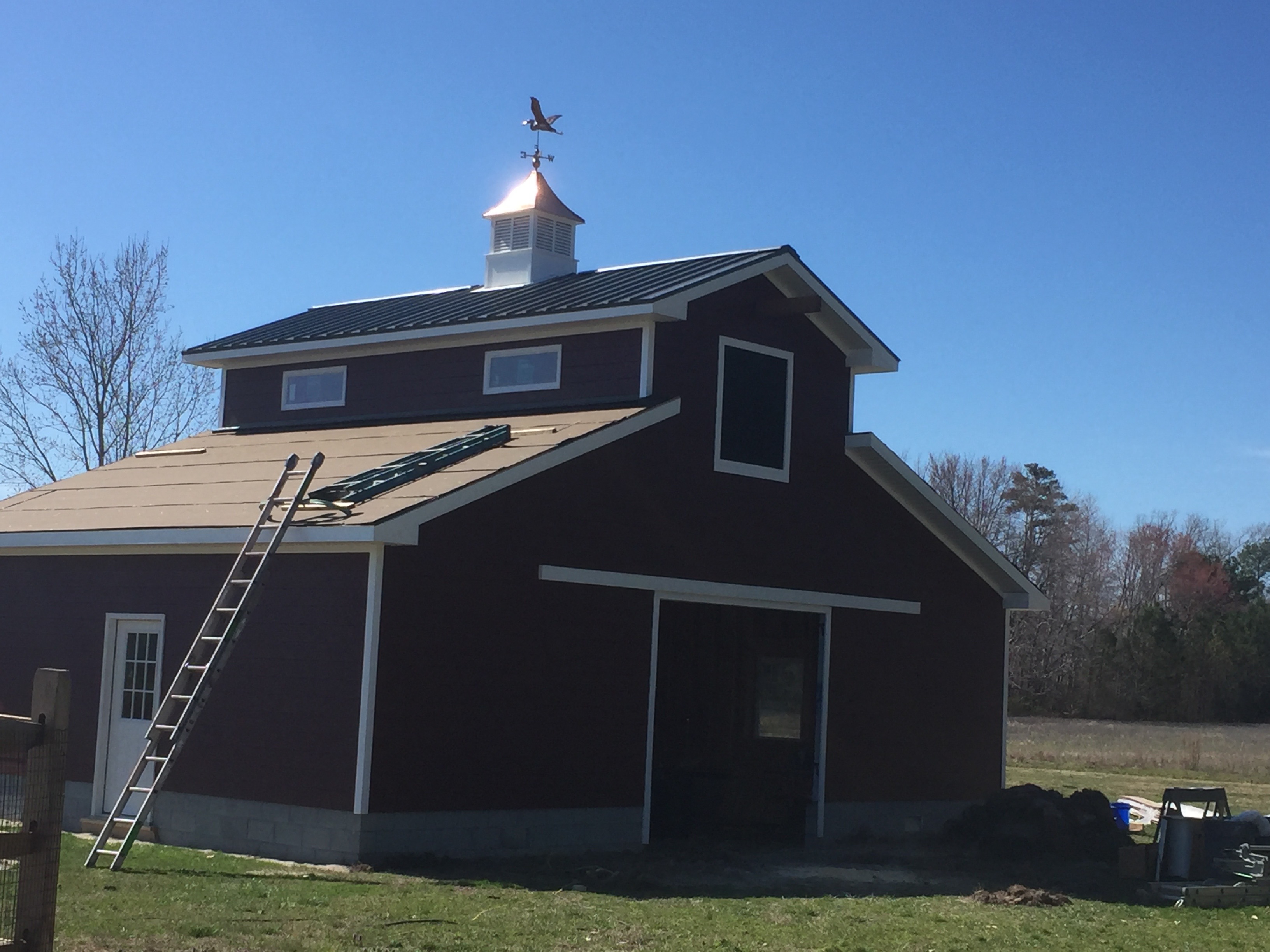

The Barn/Mike’s Toy Shed

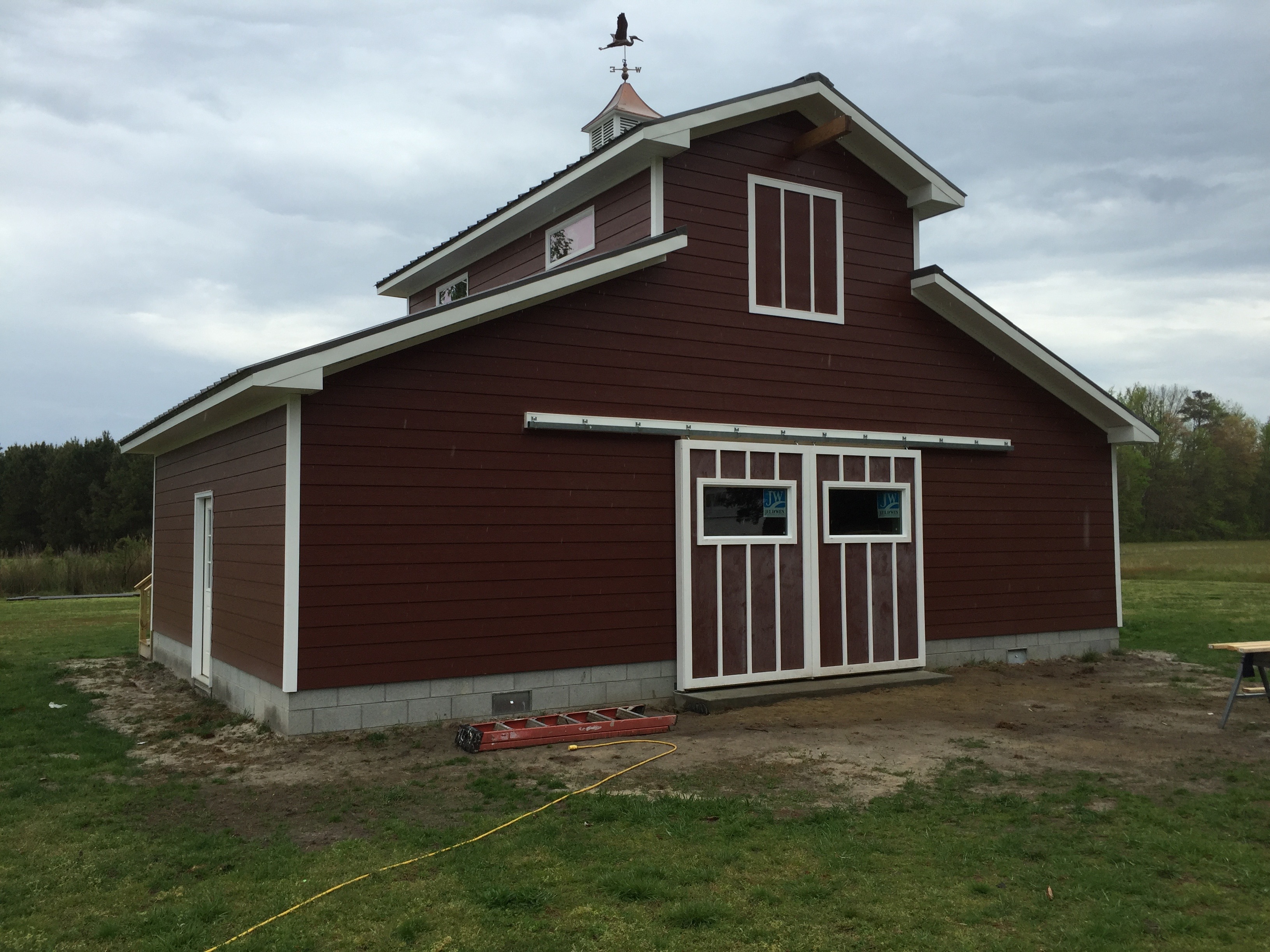

Today April 29, 2016 I am please to say the Barn construction is done.  We are waiting for Dominion Power for electricity.

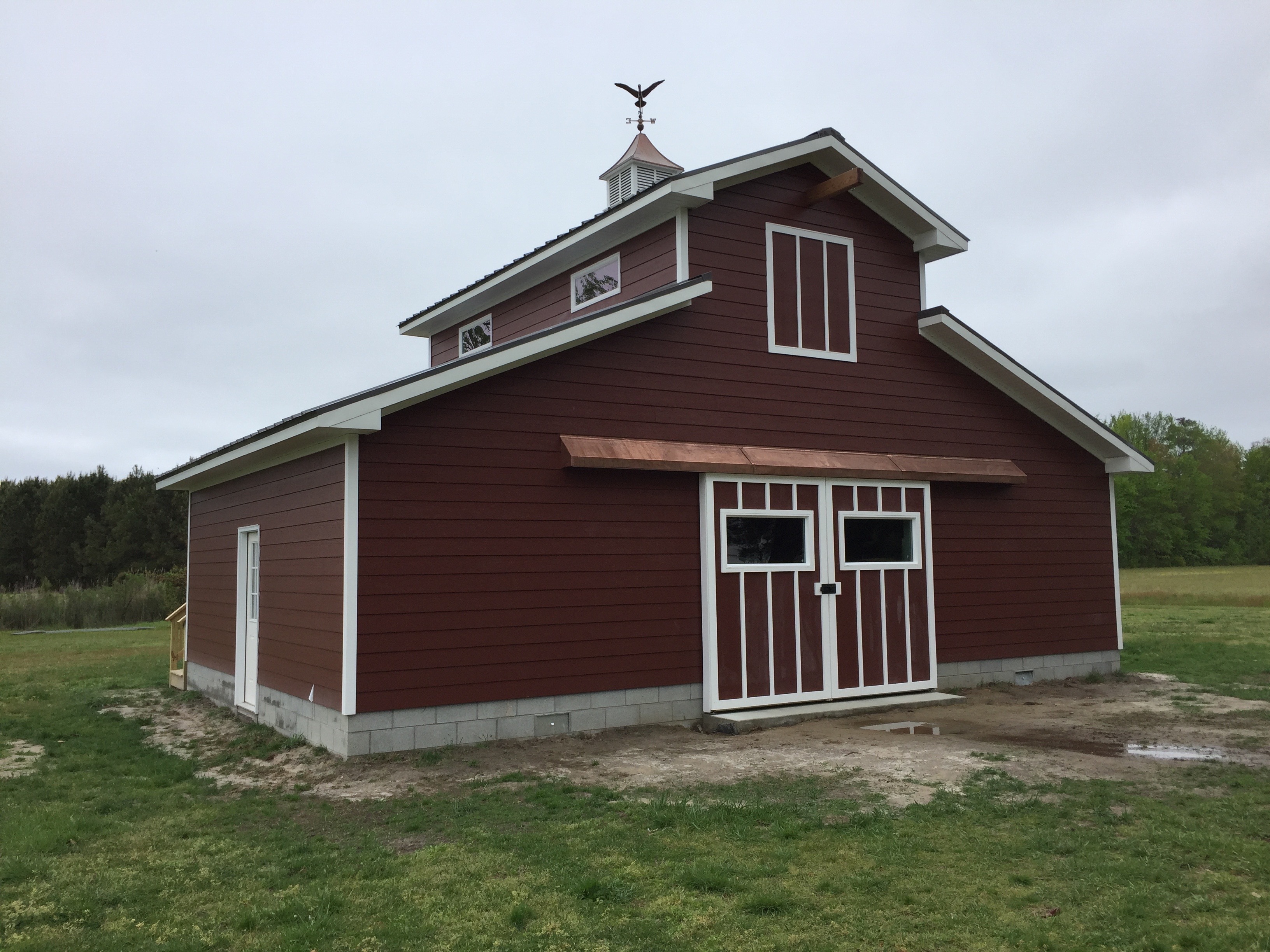

IMG_3878

Finally progress! The Hardi-board arrived damaged again, however, the supplier gave it to us for free and we have enough to do the

Hardboard being installed (4/22/2016)
Hardboard being installed (4/22/2016)

money side of the barn, the rear doors will be completed with MDO and painted withIMG_3849 color-match paint. It will still look like it was planned that way.

Batten Boards being installed
Batten Boards being installed January 5, 201

The construction details are below.

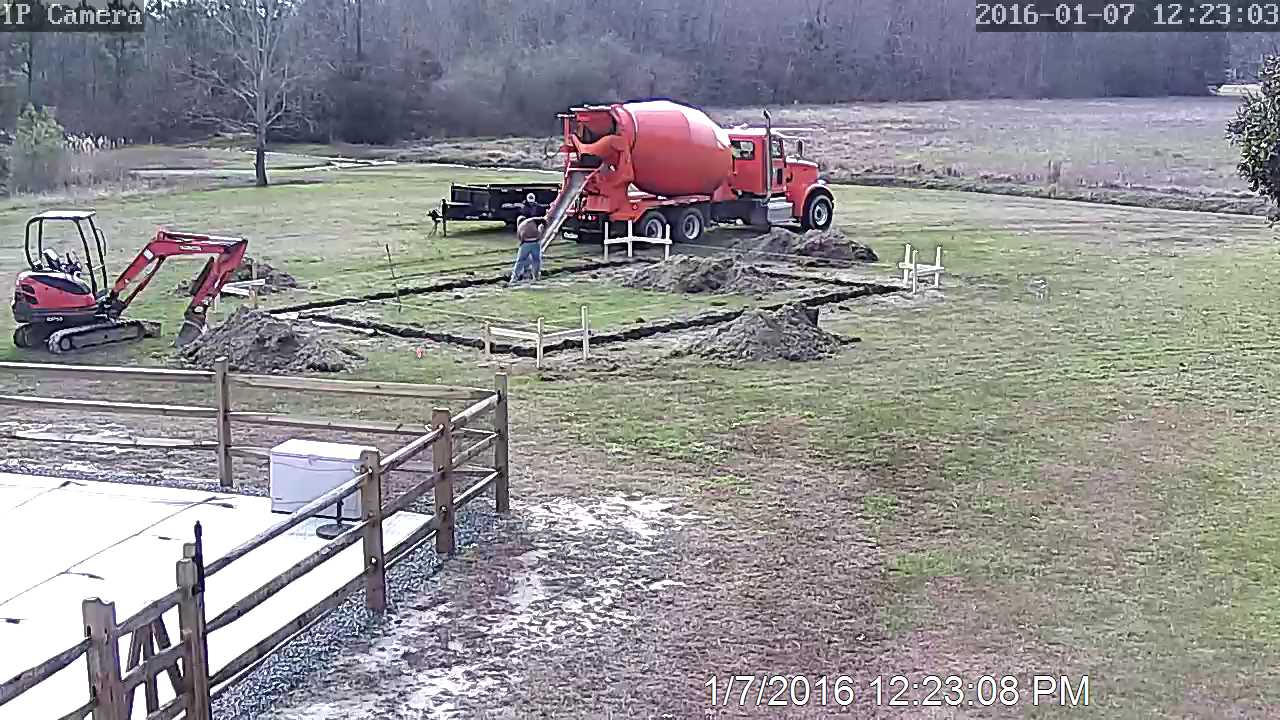

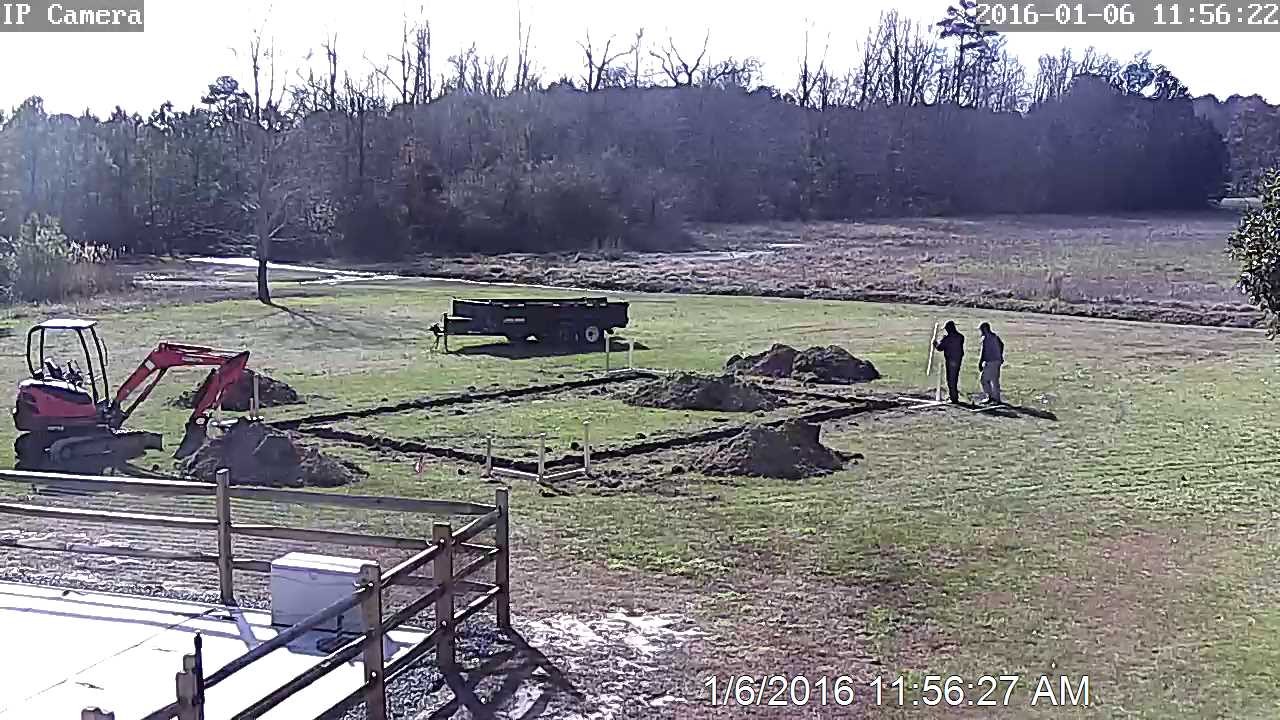

The barn construction began on January 5, 2016, The footer was dug 18-inches and inspected and the concrete was poured.

Concrete being installed in the footer trench to complete the 18-inch footer.
Concrete being installed in the footer trench to complete the 18-inch footer. January 7, 2016

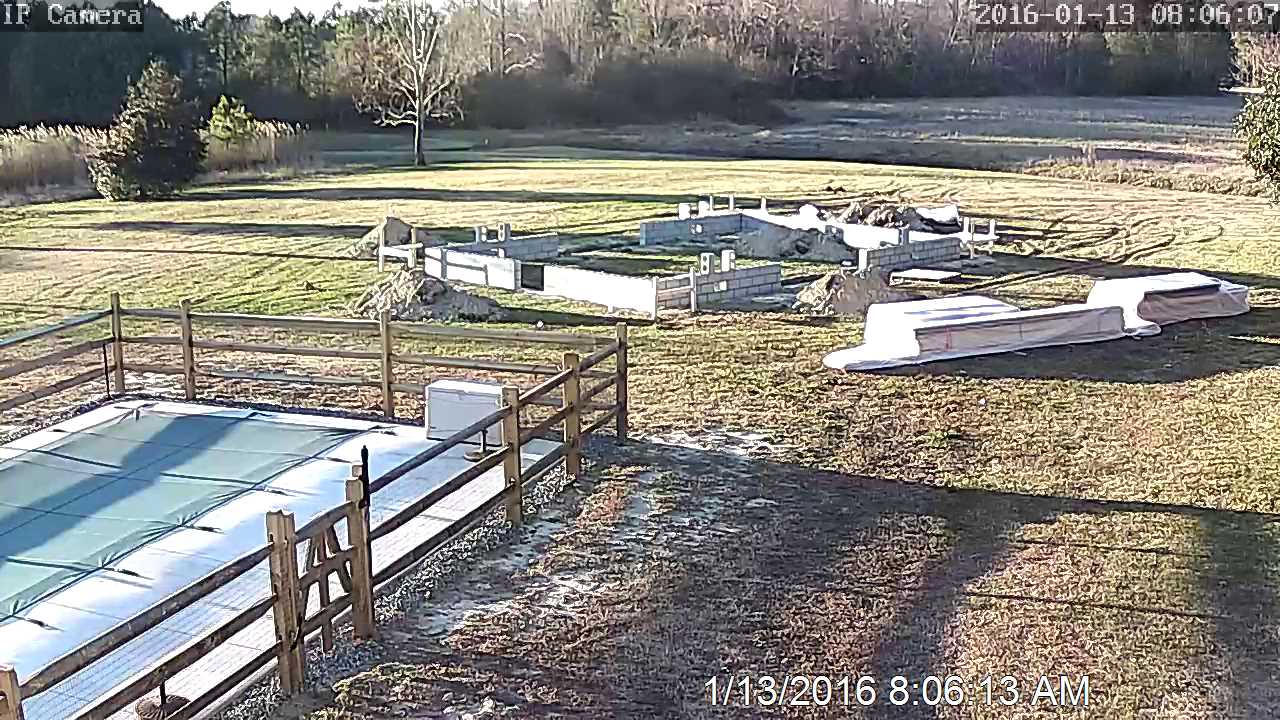

The following day the batten boards were installed by Chad and Mike.  On the 7th the concrete block was delivered.  On January 12, 2016 the three course of concrete block was

Laying of the block was completed on January 13, 2016
Laying of the block was completed on January 13, 2016

Ever wonder why old barns are usually red in color? Red is (or, perhaps, was) a popular color for barns due not to its color shade but for its usefulness.

Many years ago, choices for paints, sealers and other building materials did not exist. Farmers had to be resourceful in finding or making a paint that would protect and seal the wood on their barns. Hundreds of years ago, many farmers would seal their barns with linseed oil, which is an orange-colored oil derived from the seeds of the flax plant. To this oil, they would add a variety of things, most often milk and lime, but also ferrous oxide, or rust. Rust was plentiful on farms and because it killed fungi and mosses that might grow on barns, and it was very effective as a sealant. It turned the mixture red in color. When paint became more available, many people chose red paint for their barns in honor of tradition.

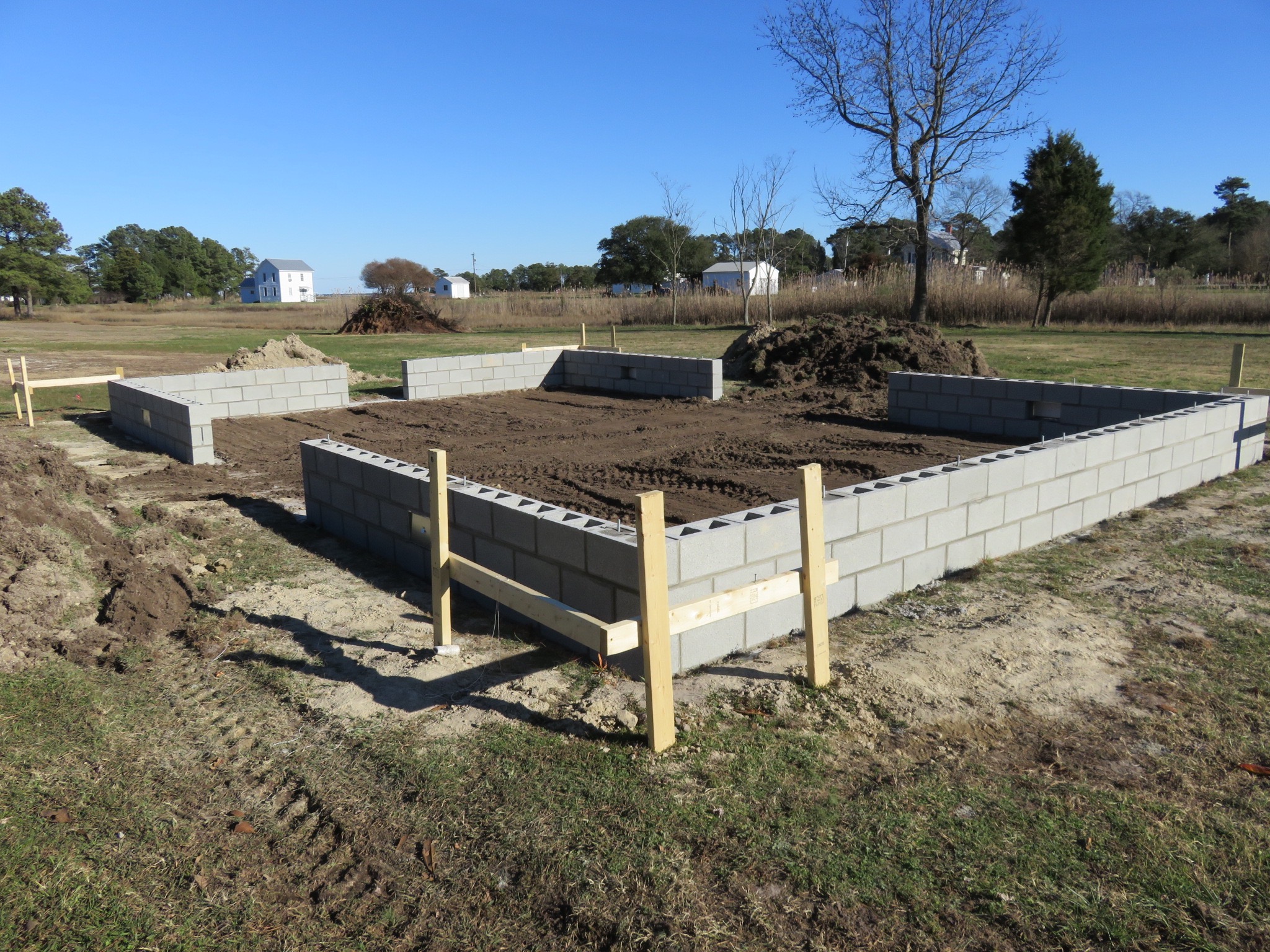

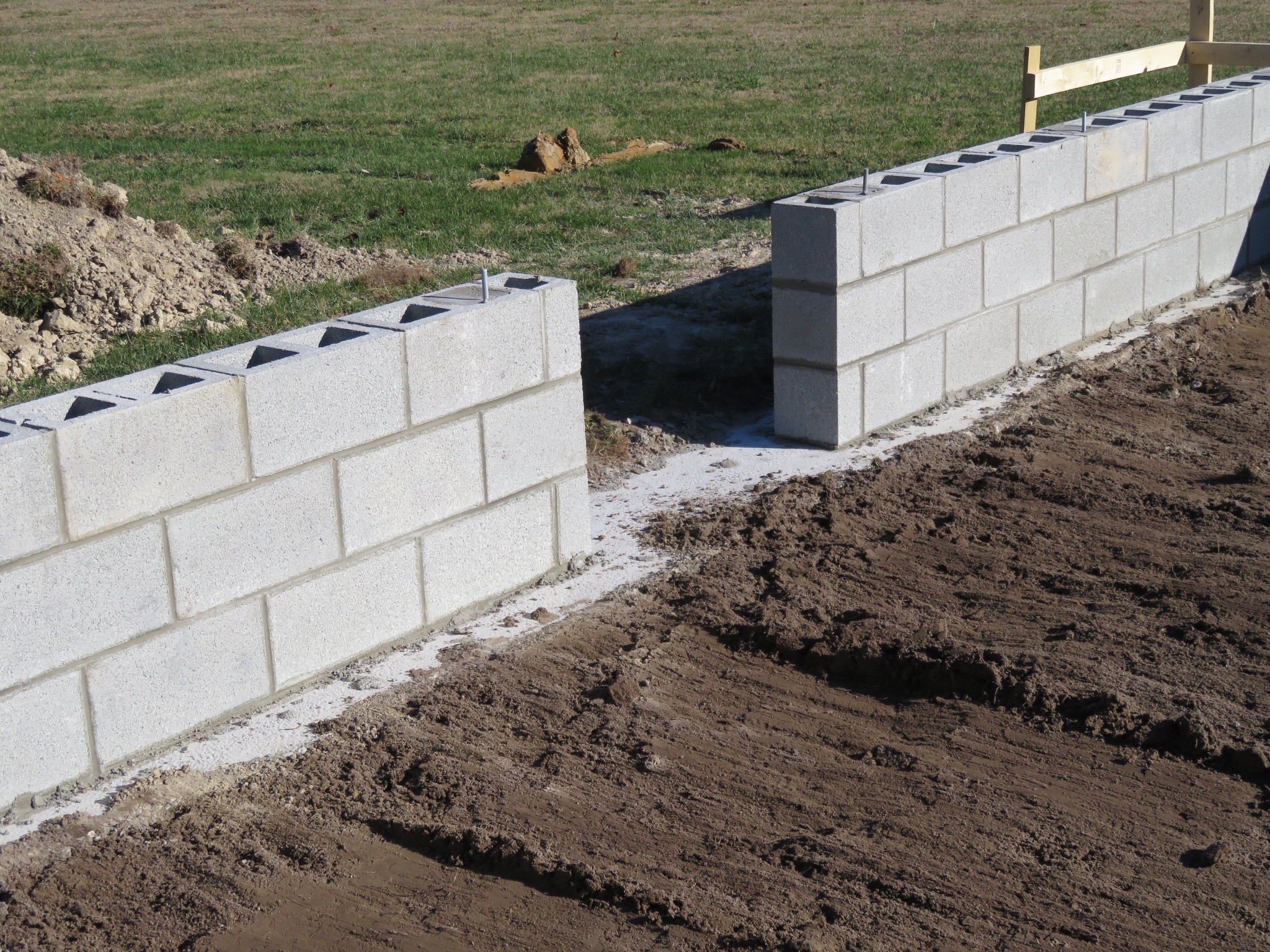

installed leaving space for two 10-foot barn doors and a 36-inch side entry door.  The first shipment of lumber was also deliIMG_5425vered. Today January 13, 2016 the concrete contractor returned to scrap the topsoil from the barn making the soil even with the top of the footer. IMG_5424

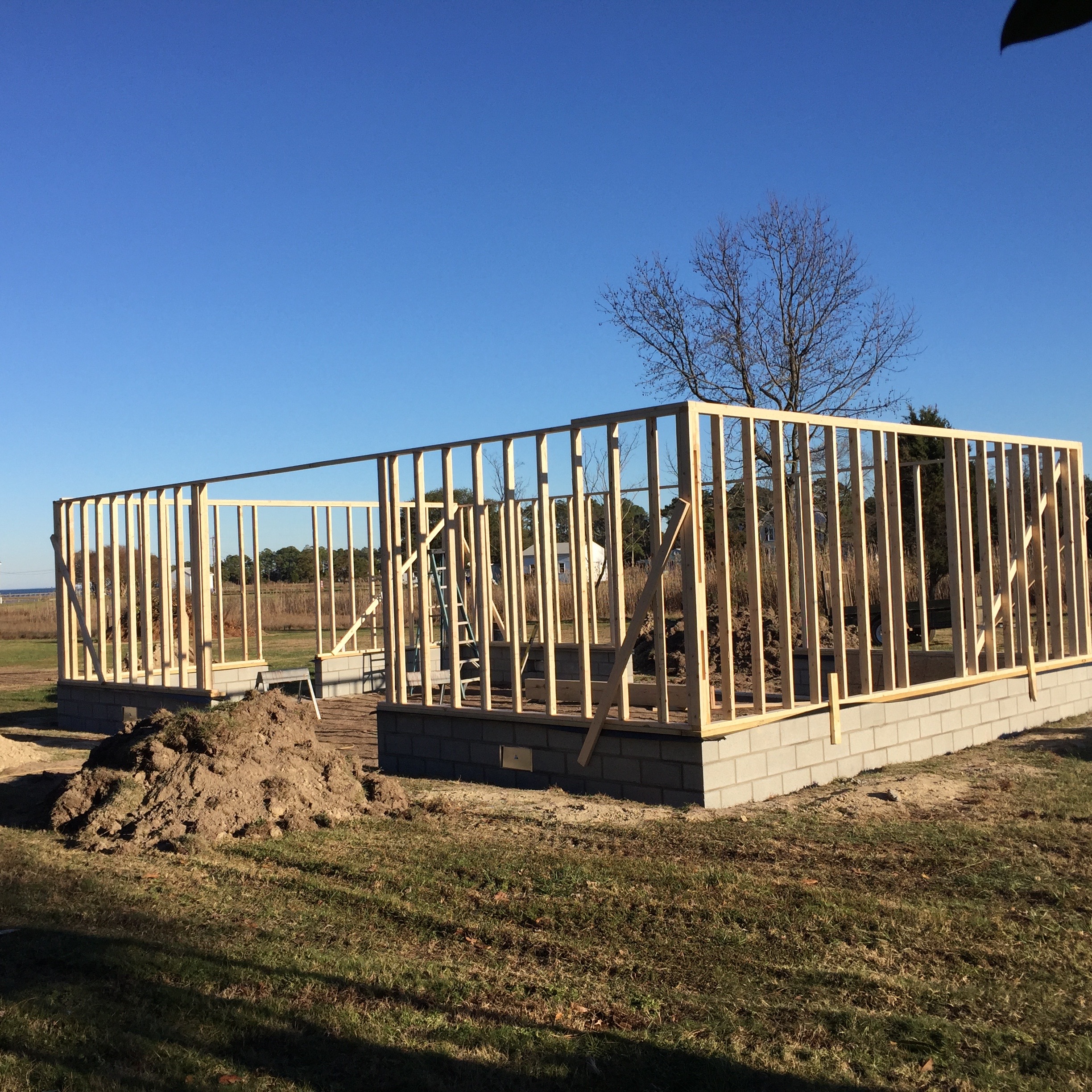

IMG_3593

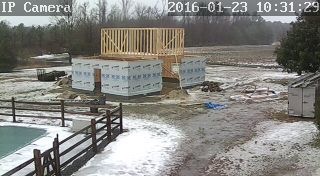

January 14, 2016

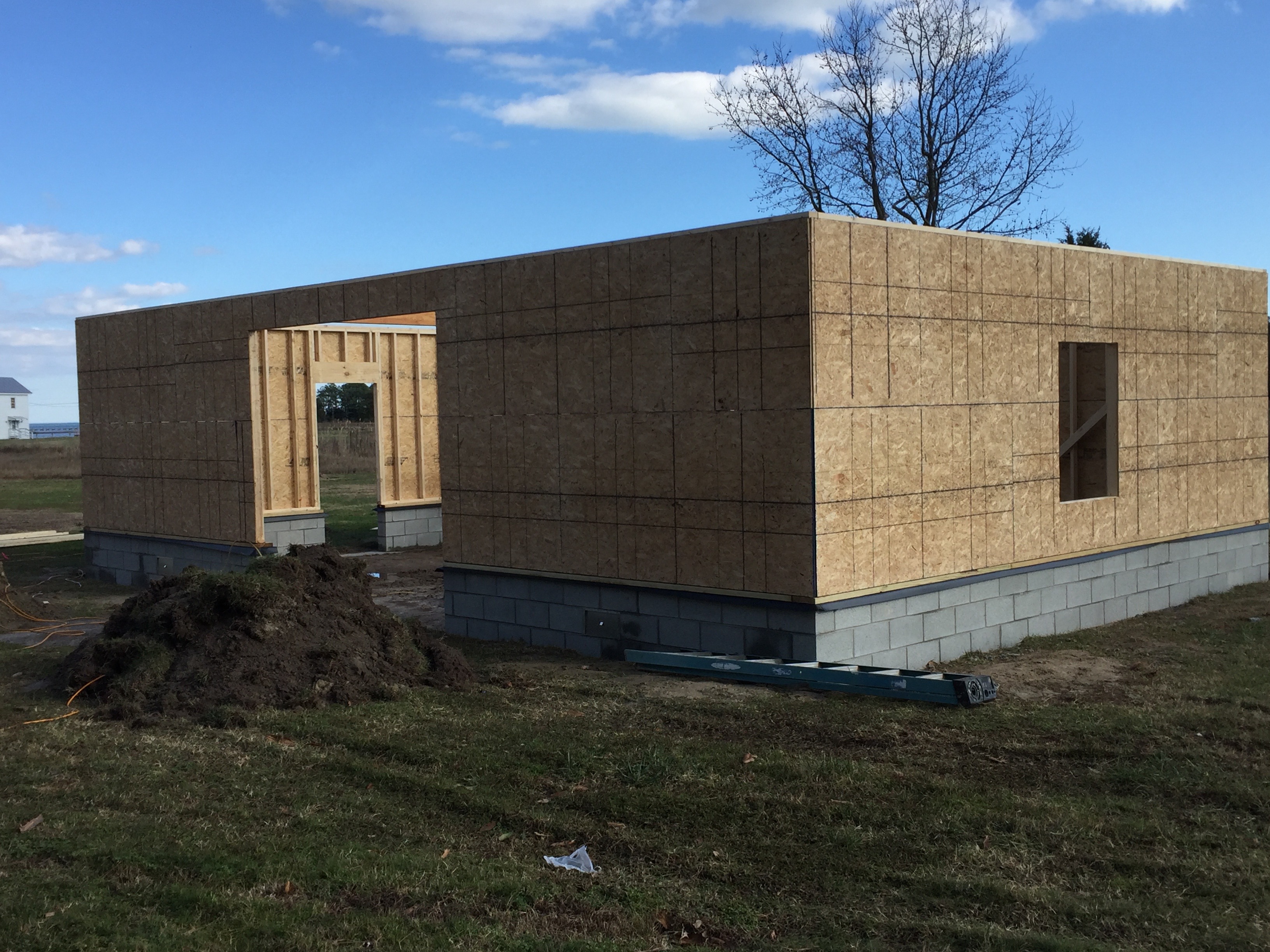

IMG_3596
January 15, 2016

Work continues on the barn with framing, and sheathing being added, in addition the two front to back lam-beams are in place.  Saturday we picked up the door that was ordered and the windows will come in in about a week.  We had rain and some snow over the weekend so hopefully work will continue on Monday (1/18). Well we got some snow over the weekend, the Northeast is referring to it as the Blizzard of 2016.  WE got 12-inches in Richmond but far less in New Point.  Construction continues on the Barn regardless of the weather.

Progress as of January 22, 2016
Progress as of January 22, 2016

The barn door hardware has arrived and will be delivered tomorrow 1/26/16.

Work continues on the bard, the framing is

February 2, 2016
February 2, 2016

almost complete. The roof sheathing is on and we have decided to go with a metal roof from

Corrugated Roofing in Acrylic Coated Galvanized steel
Corrugated Roofing in Acrylic Coated Galvanized steel

Union Corrugating we have also added a cupola and a weather vane

Cupola and Weather Vane from Valley Forge Cupolas
Cupola and Weather Vane from Valley Forge Cupolas – Click image for the full view.

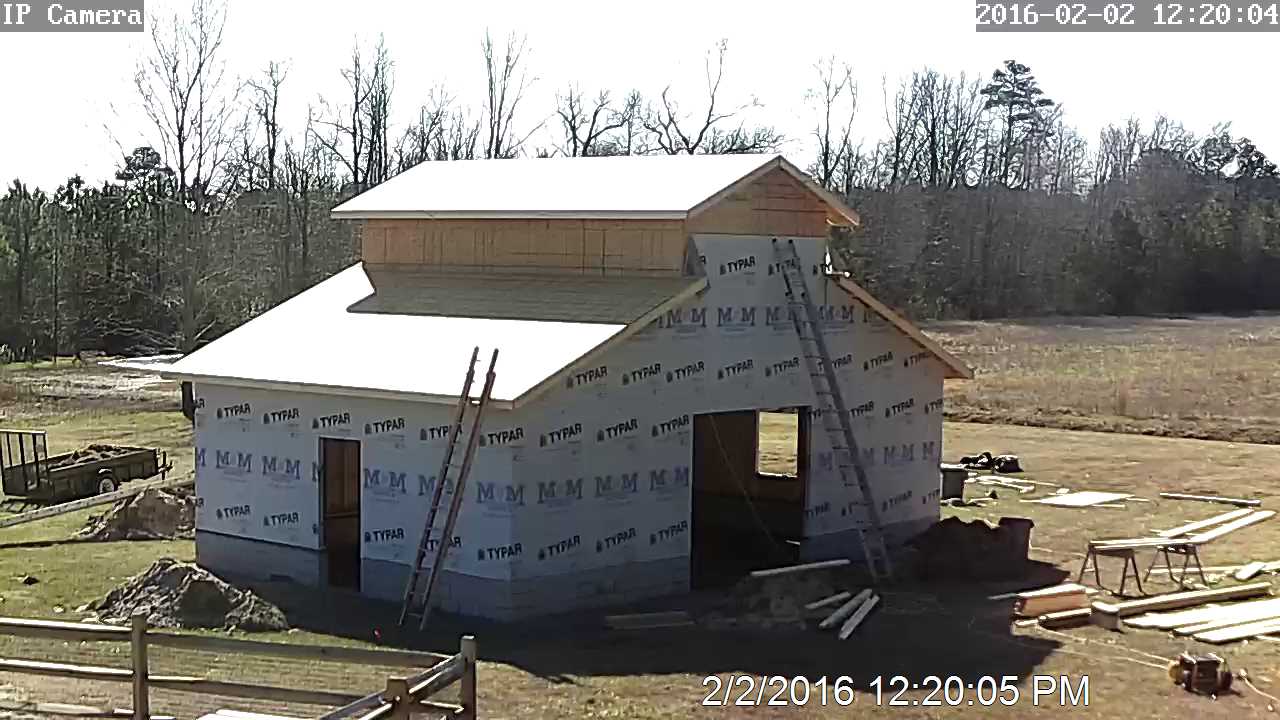

to the project from Valley Forge Cupolas. Tarpaper was installed late in the CrkPool.20160202_155414afternoon in anticipation of rain tomorrow (2/3/2016).

Roofer stopped by to check job site and provide and updated quote for the change from tab shingles to steel.
Roofer stopped by to check job site and provide and updated quote for the change from tab shingles to steel.

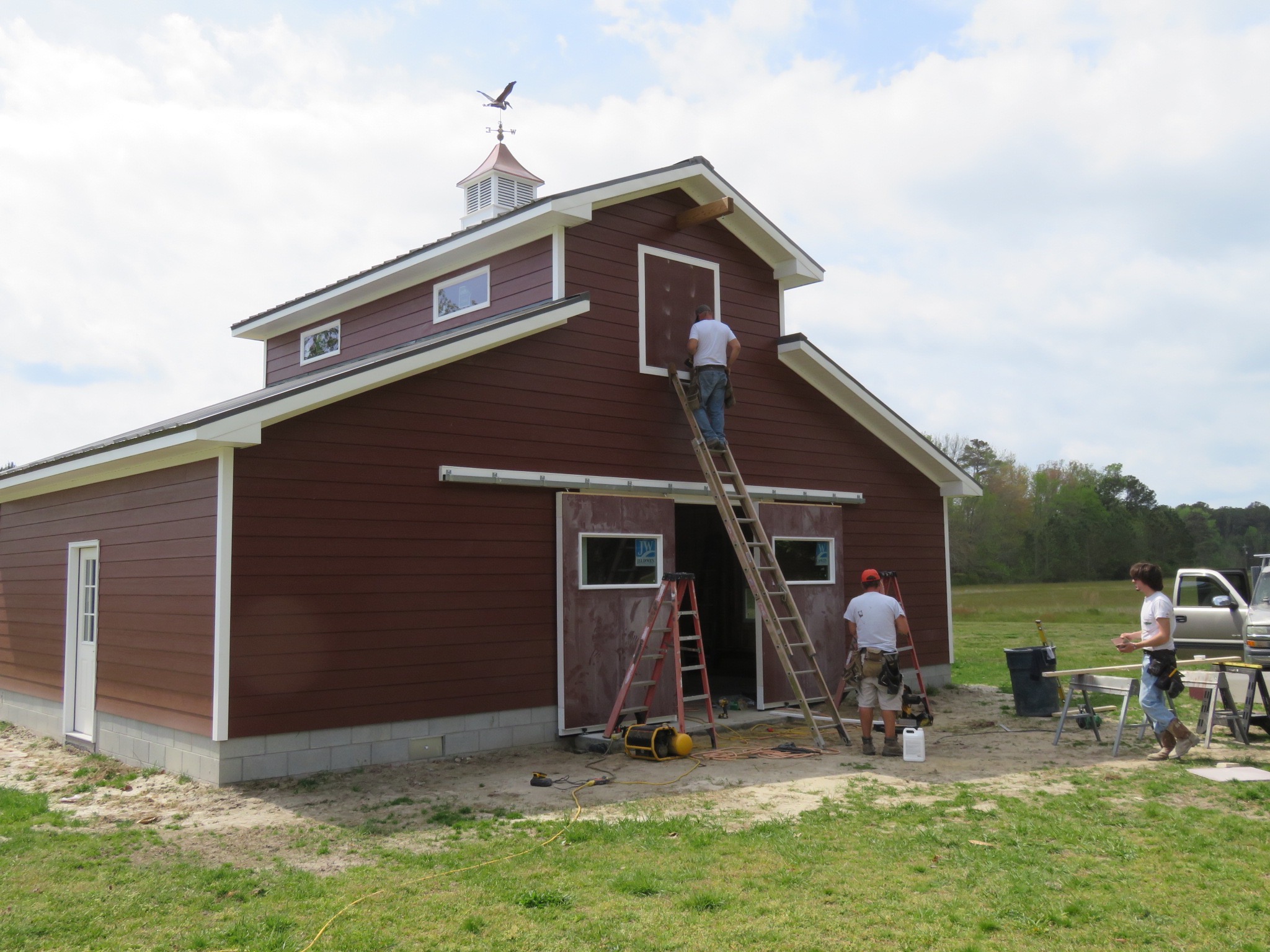

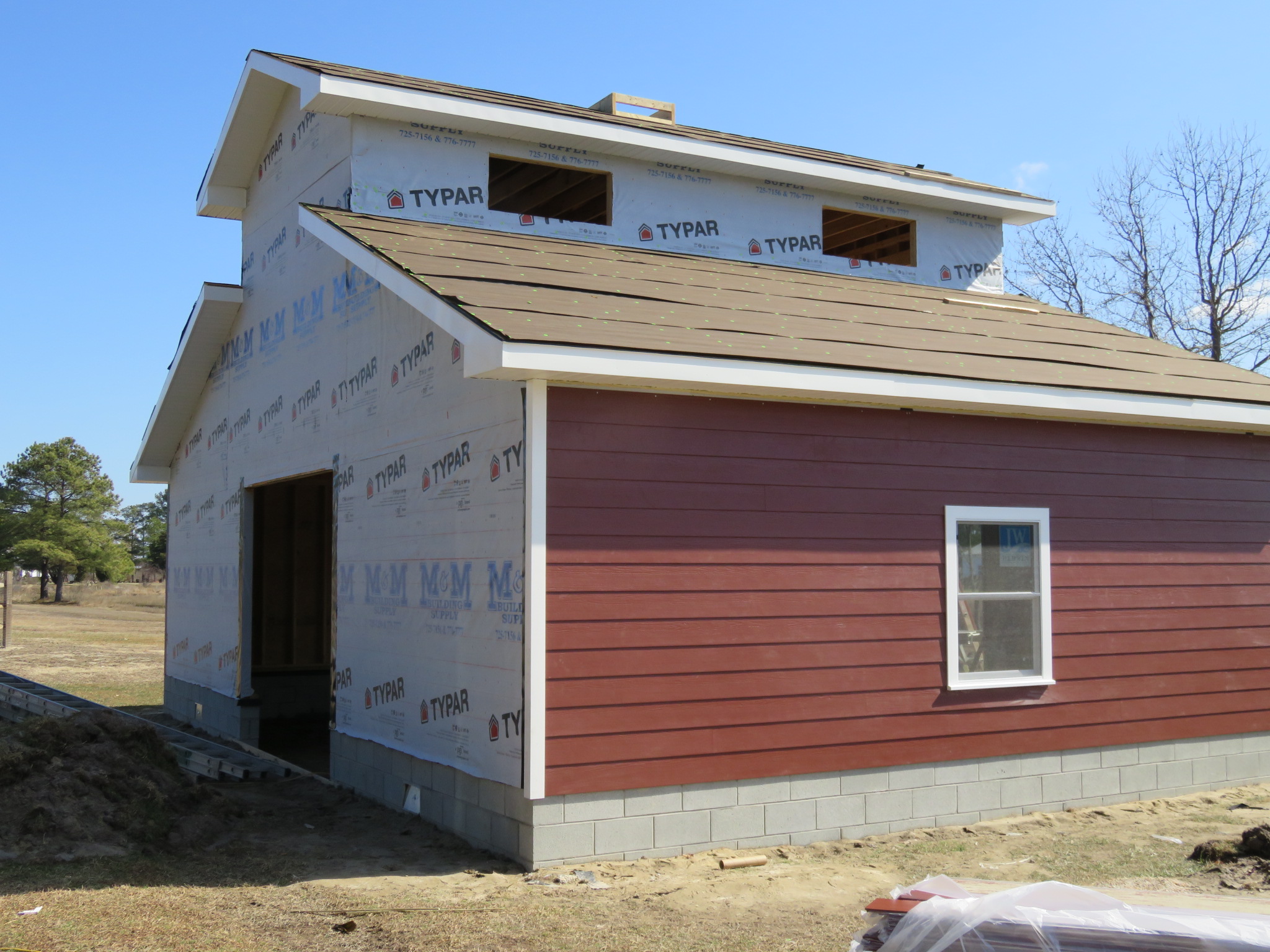

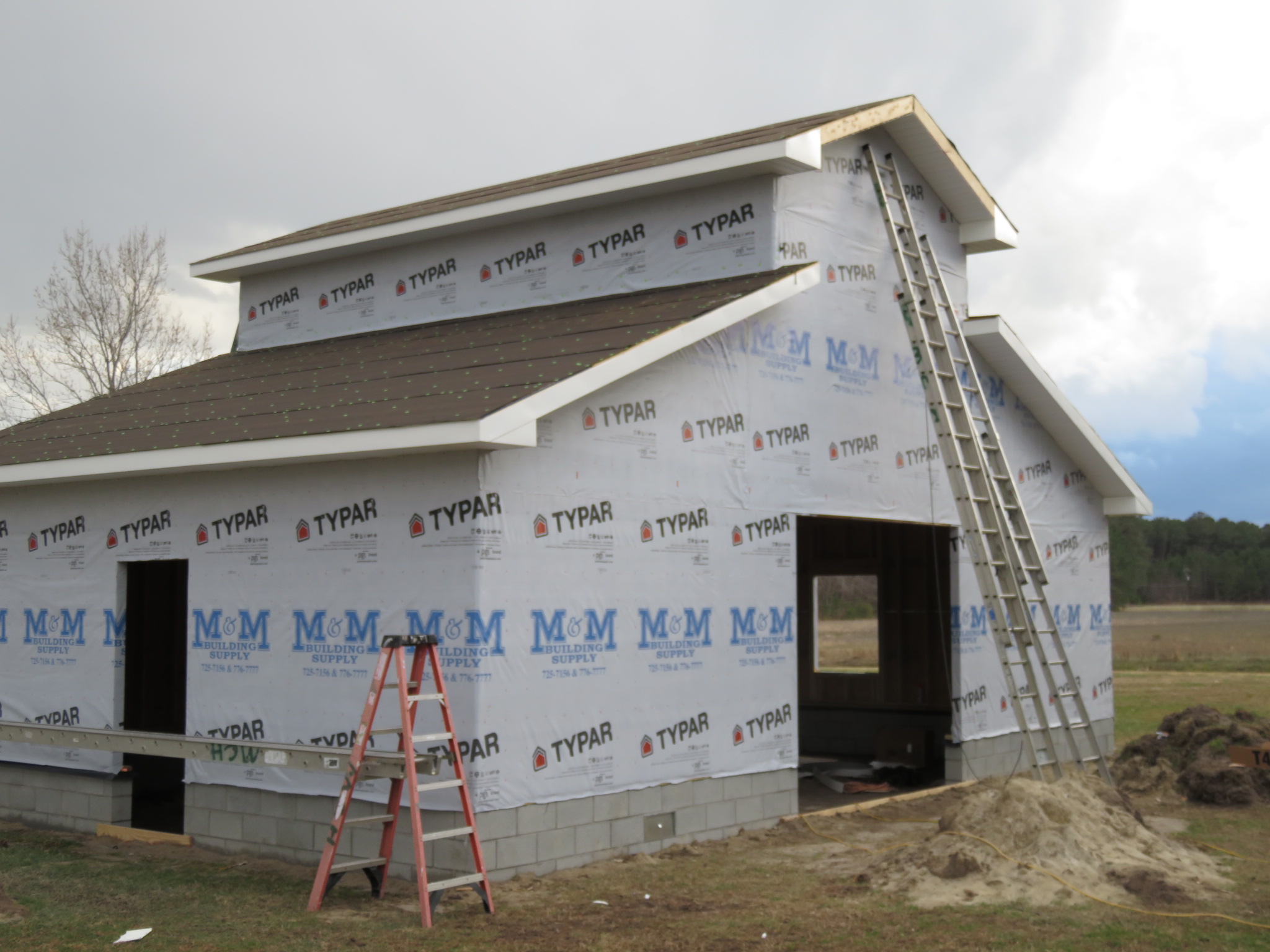

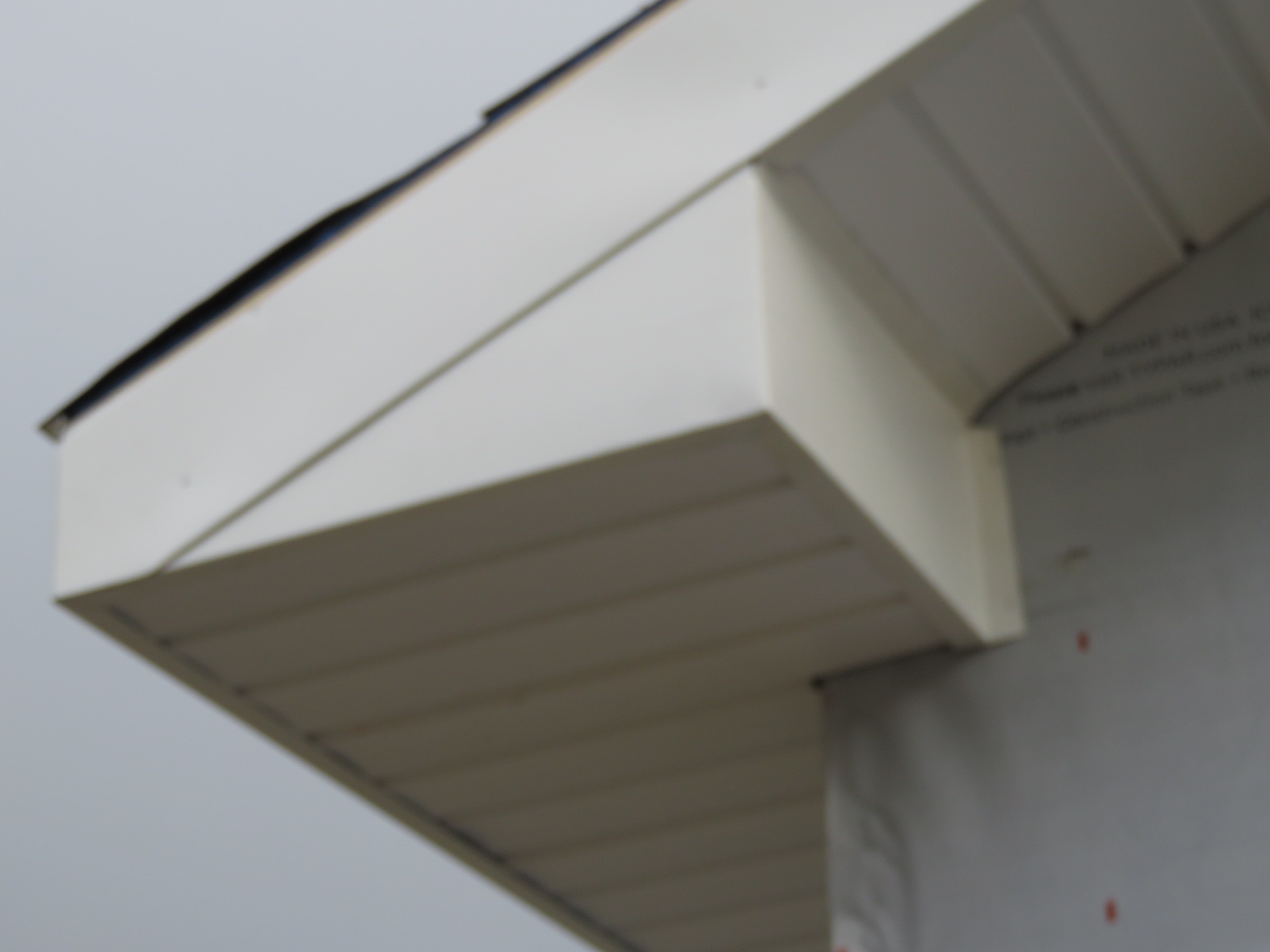

Progress continues (2/8/2016) with the addition of soffits and trim, including soffit end boxes to provide a more finished look and IMG_5431to match the Bunkie construction elements.  Today Pat tried to hi-Jack my barn door windows, however we decided to purchase new windows, only slightly smaller (20″x48′) that are awning style that open for additional ventilation. There willIMG_5433 be two on each side.  We also reworked the stair design to the second floor to the outside to increase interior square footage. IMG_5434I also added lights to the cupola which should look very cool when the barn is done. Work continues on the barn (2/18/2016) as the side window has been installed and the openings cut in the second floor fIMG_5436or the windows and entry door.  The siding is going on as well. The second story of the barn will be used for storage and we have decided to opt for an internal VersaLift  for moving items to the storage area avoiding the stairs.

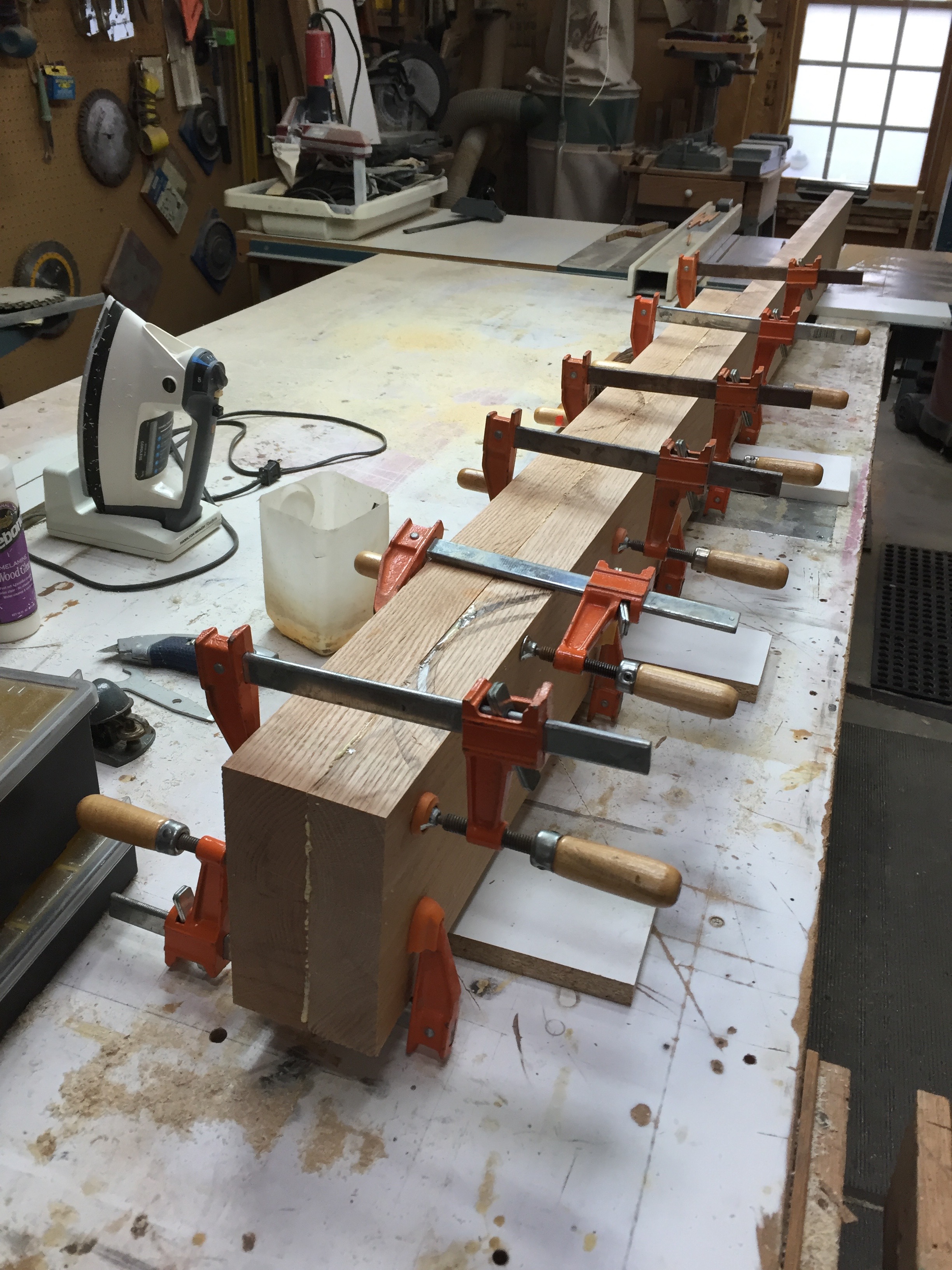

Glued and clamped oak
Glued and clamped oak

To provide the look of an old barn I decided to install a Hay Track Beam and a double pully for the barn.  The beam wasIMG_3737 constructed from oak that was 1-¾” by 7″ by 8 foot long.  I glued two piece together to give it more of a beefy structure (7″x4″) and then doweled the two pieces together to

Finished Hay Track Beam
Finished Hay Track Beam.

provide more of a post and bean construction look.

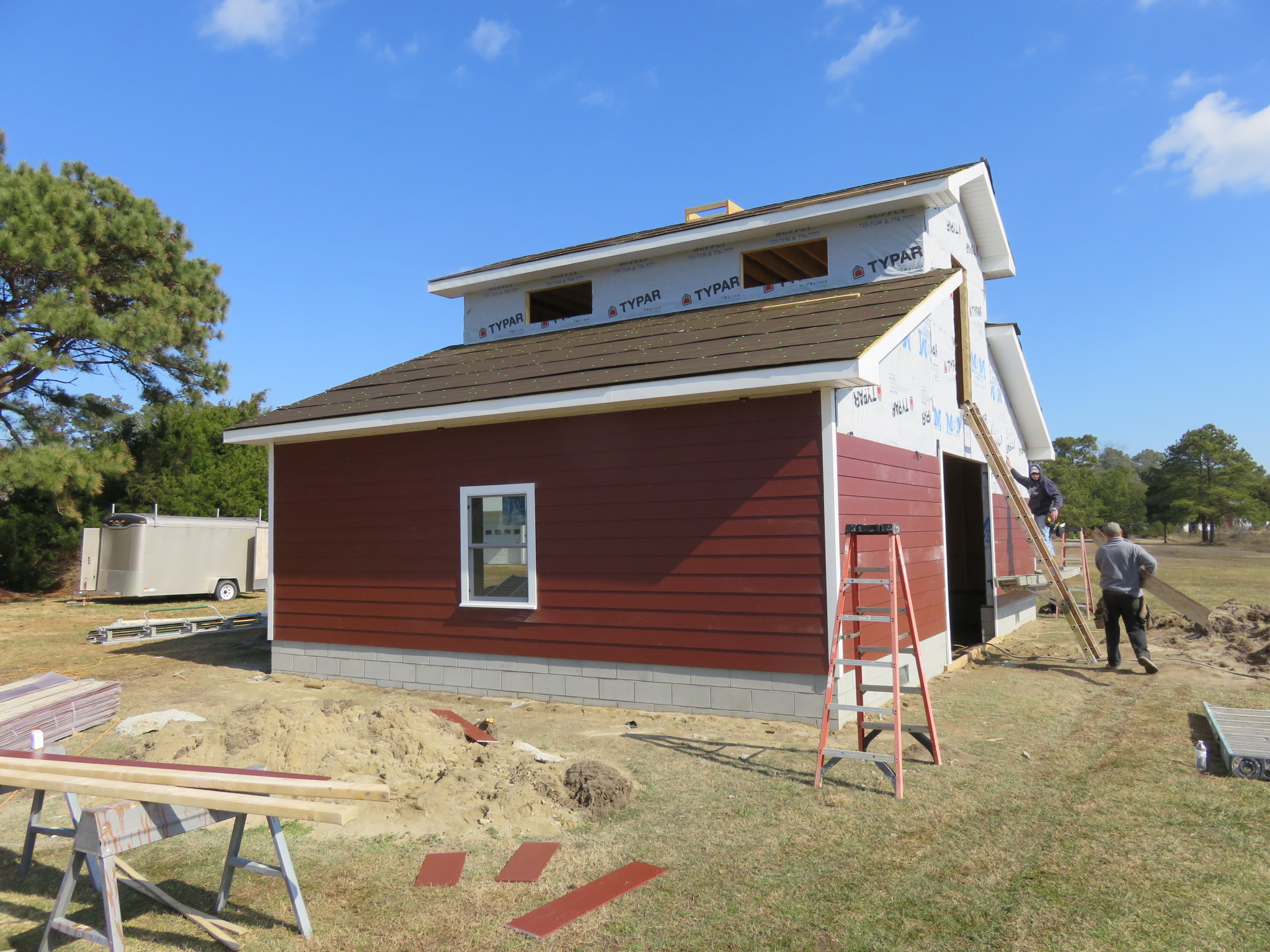

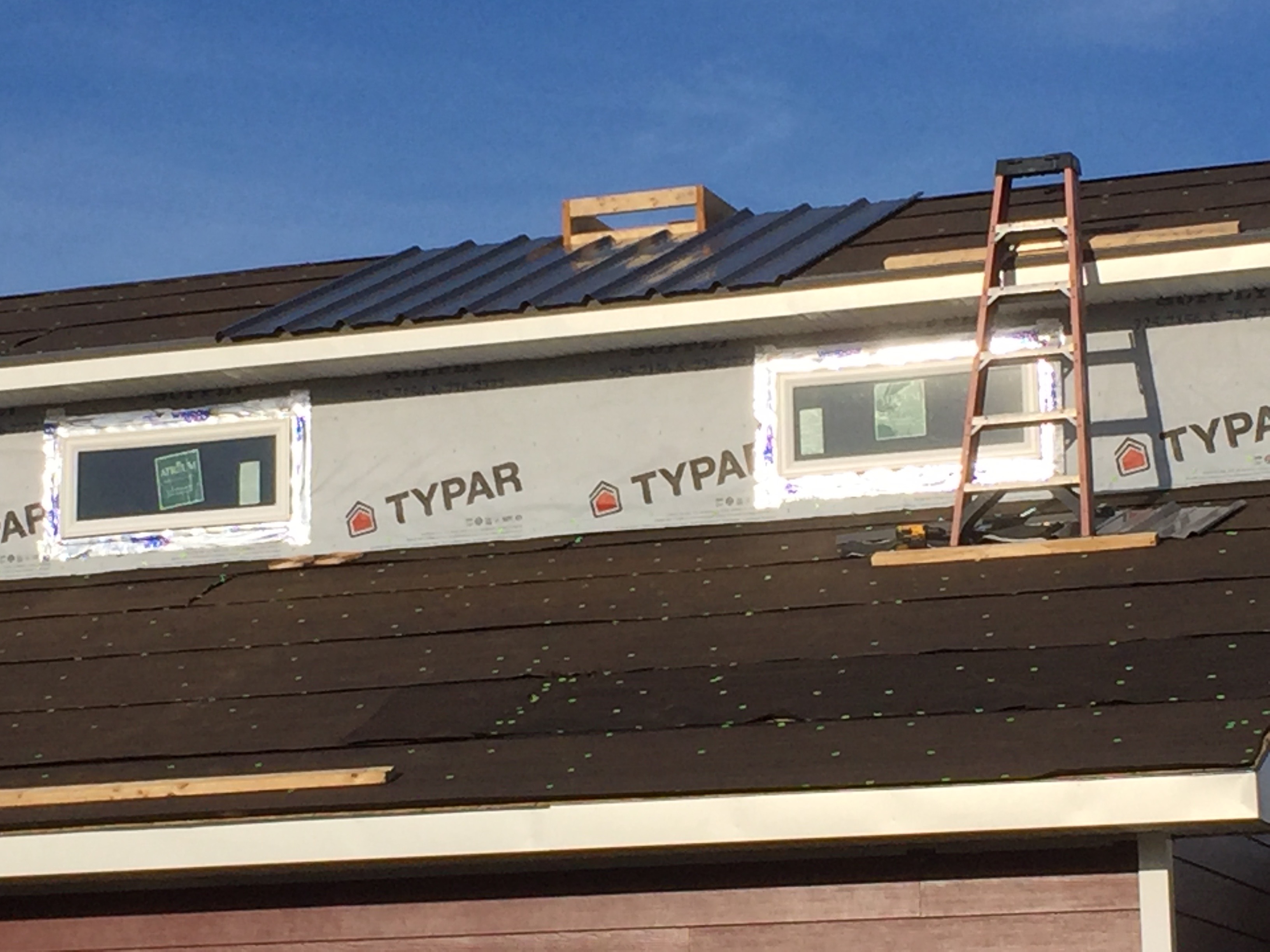

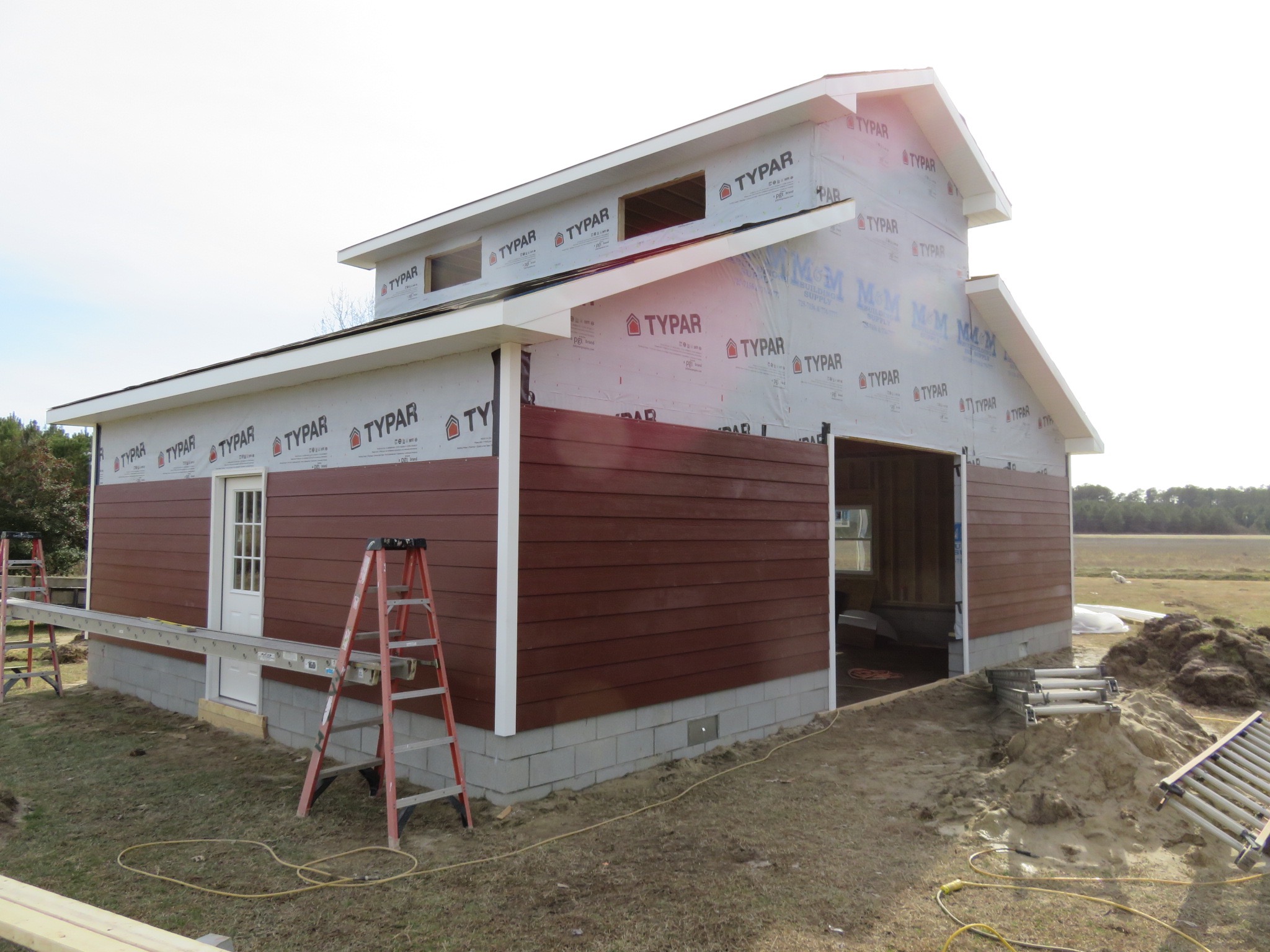

The windows for the second story have

Progress Photo 2/19/2016
Progress Photo 2/19/2016

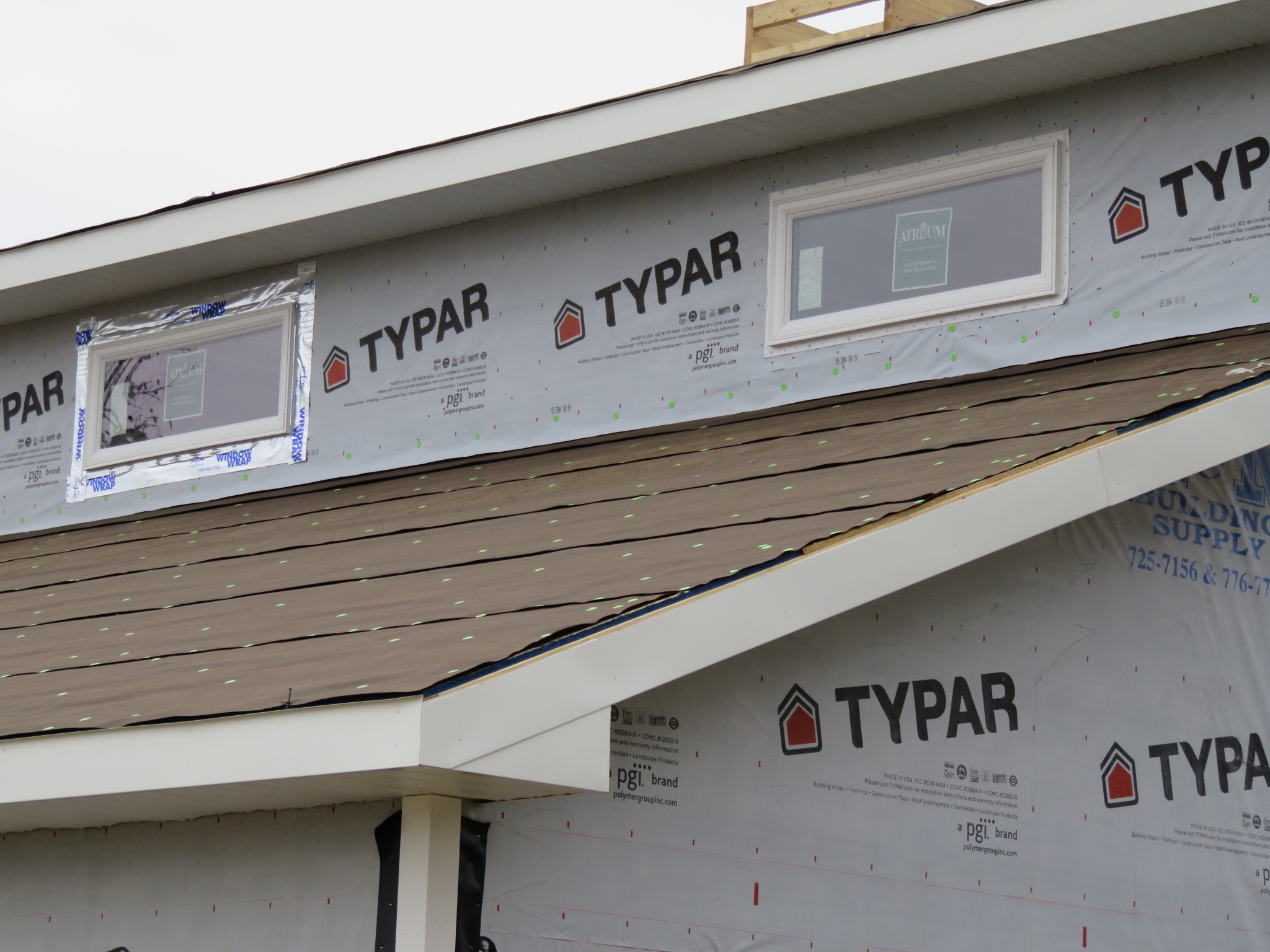

IMG_5445
(2/22/16) Windows installed

arrived and the steel for the roof is in as well so things should move along pretty quickly from now going forward.  The windows for upstairs were installed, however, closer inspection of the roofing showed the distributer shipped the incorrect color, Pearl Gray Vs. Charcoal Gray and the flashing was a mix of both. So much for quality control! Yesterday the ledger board for the rear entry deck was hung and the rail mounting board were hung and wrapped in aluminum in

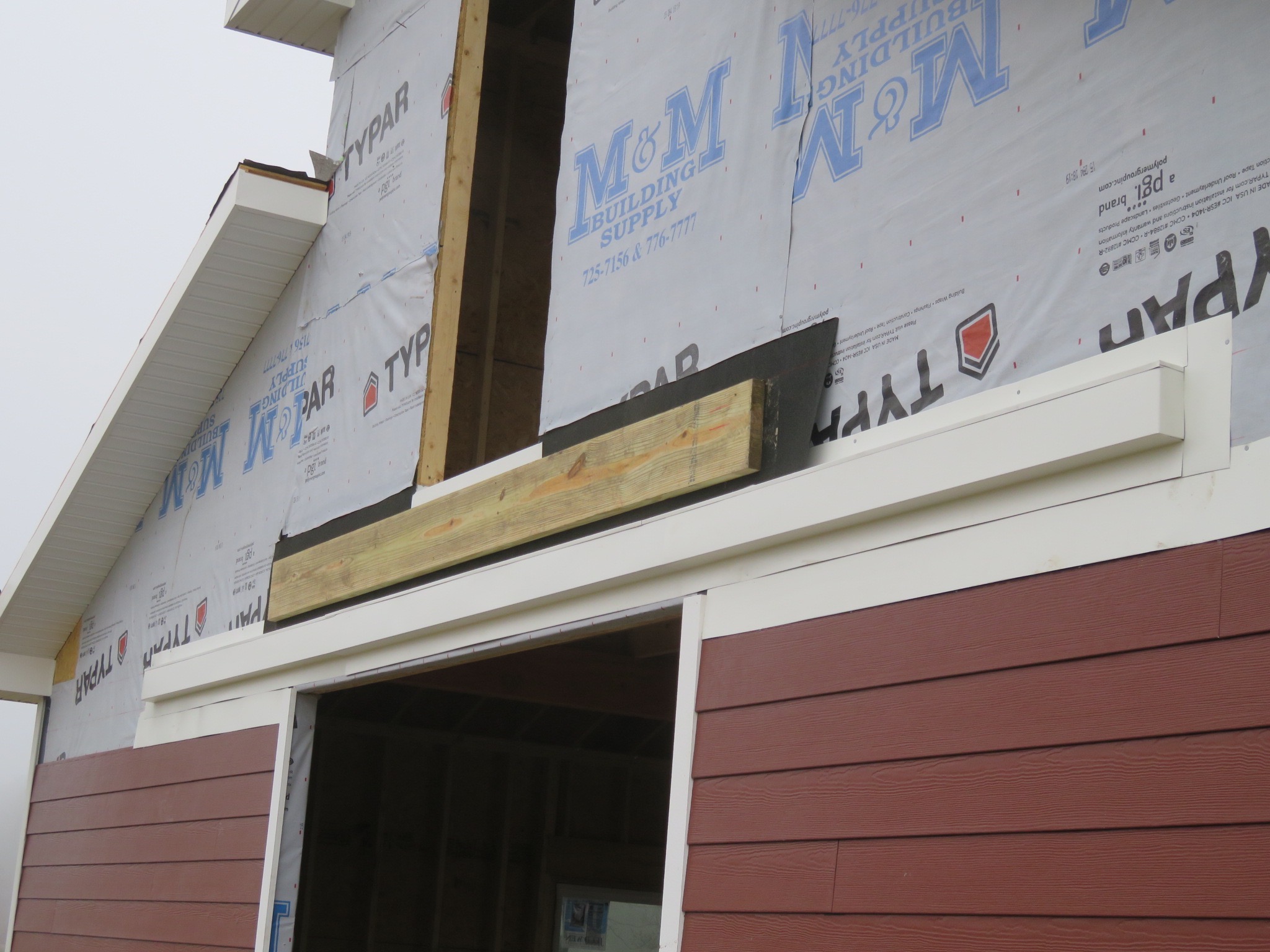

IMG_5446
(2/23/16) Ledger board for decking and Barn door Rail support
IMG_5453

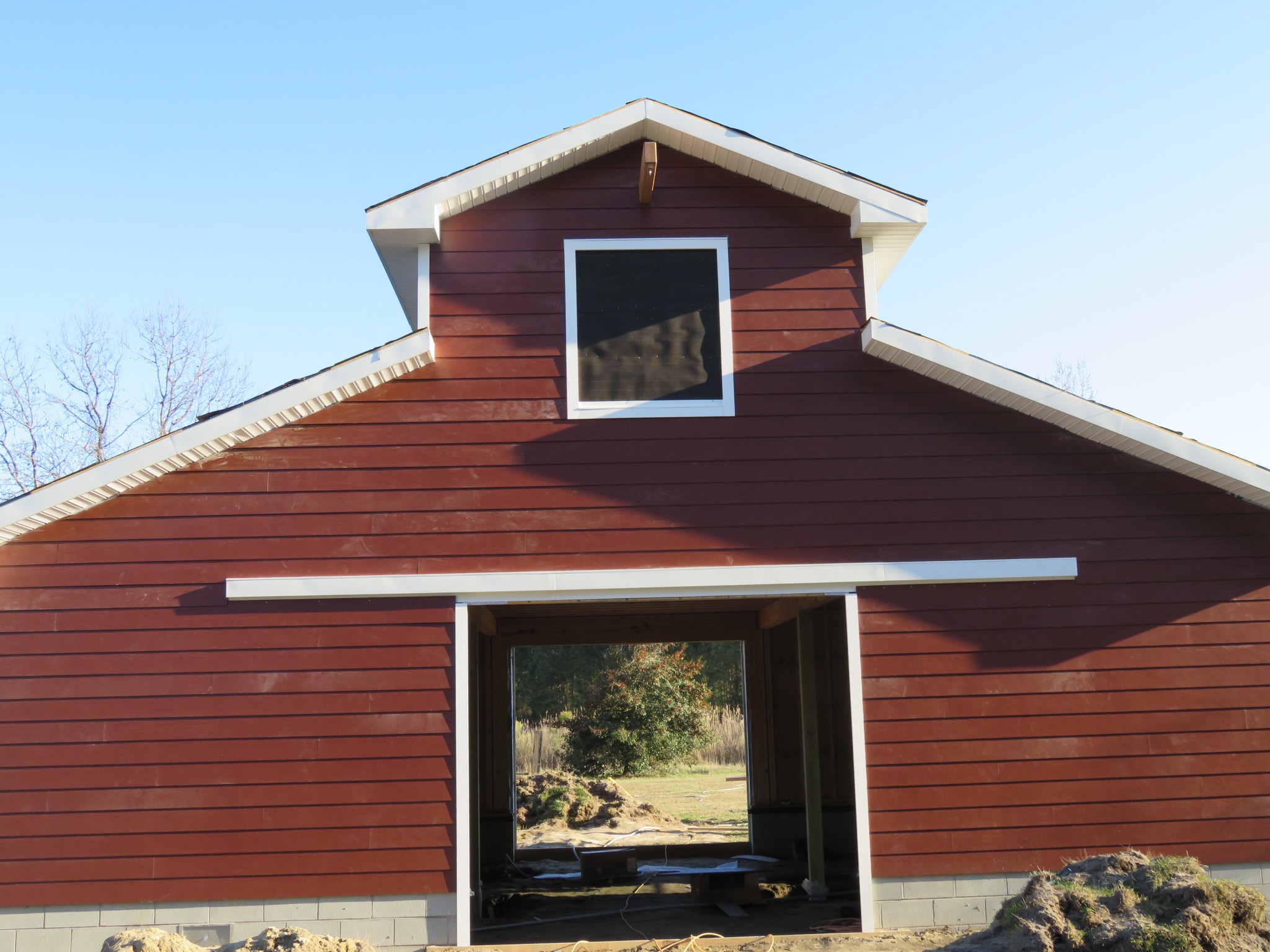

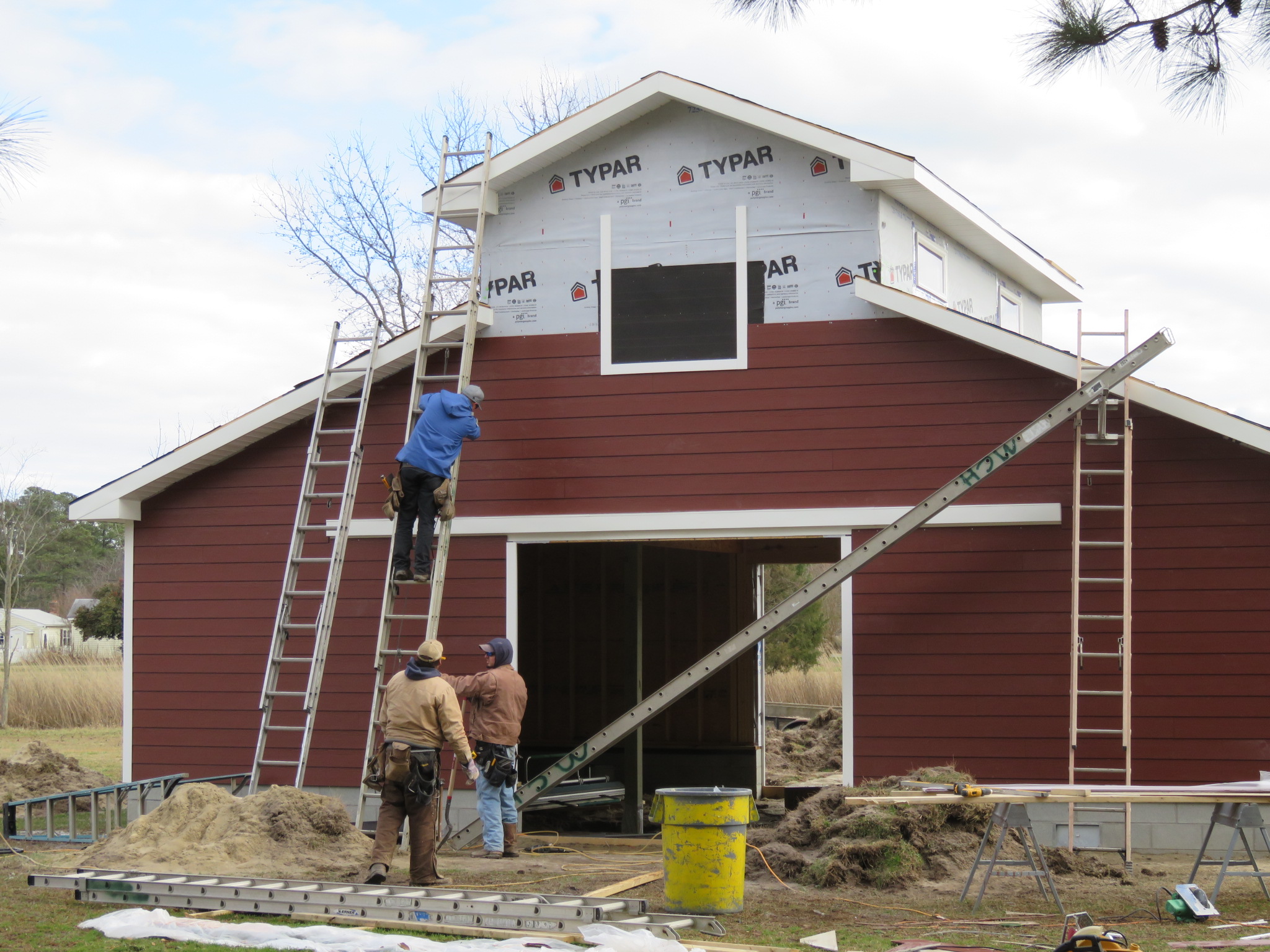

Siding on the front of Barn almost complete. Still needs trim board and center panel for faux loft entry.(2/26/16)

preparation for the barn door railing system.  I also discovered I ordered more door hangers than needed so I can take some back.

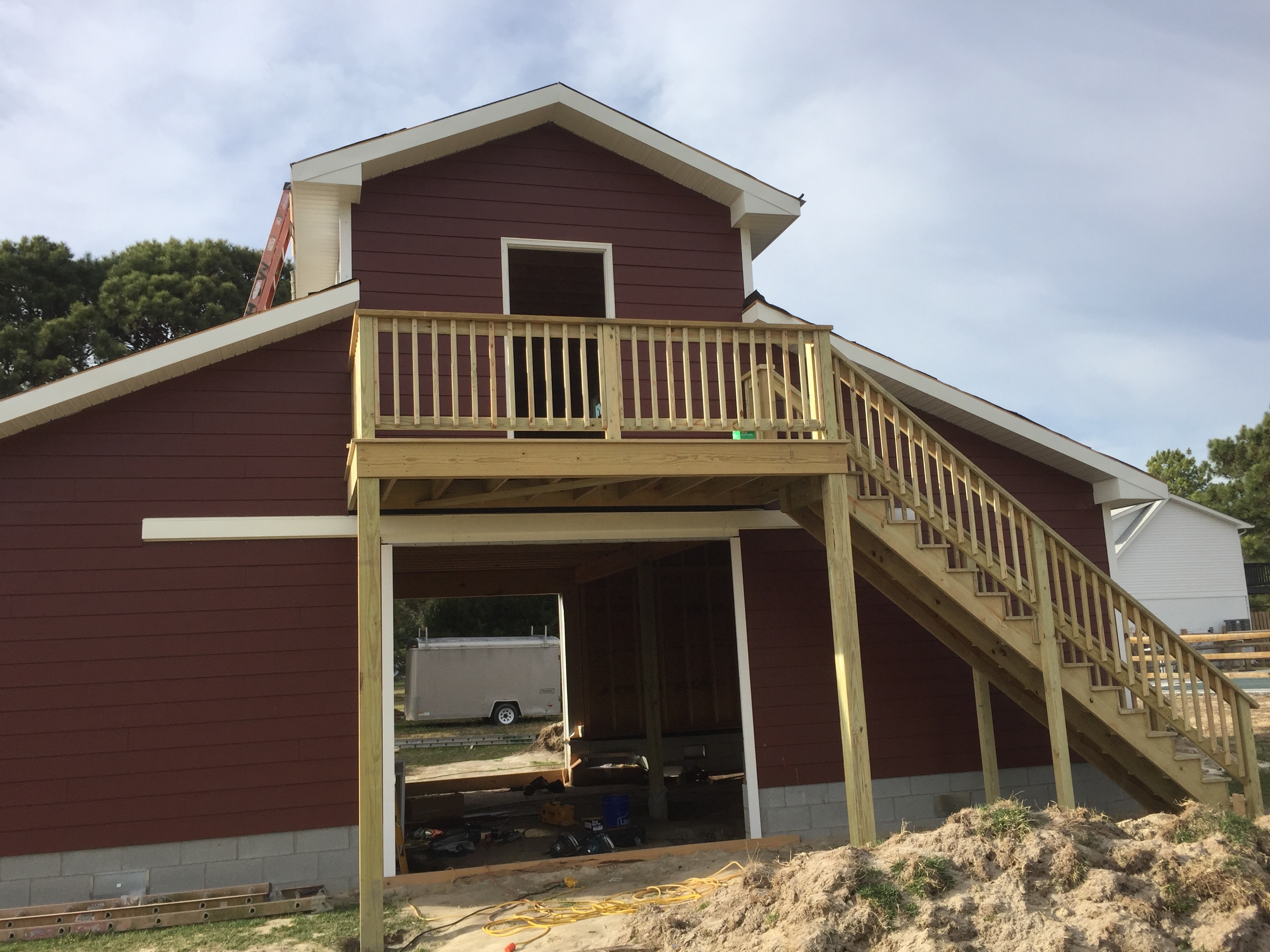

IMG_3747
The stairs to the second floor on the rear are now complete (3/10/16)

Were presently in a rain delay (2/24/2016) with work happening as the team can fit it in. UPDATE (3/6/2016) Between the weather (rain) and supplier progress has been at a stand still.  The incorrect color roof and the Hardi Panels were delivered broken beyond useable even if we were willing to absorb the problem.  We’re hoping this coming week of beautiful weather will bring better luck.  Until the barn is completed we are unable to begin the relocation process from Richmond to empty the garage.
The roofers arrived yesterday and began the job of installing the metal roof.  We needed 98″ of run on the upper roof so we had to order 10′ panels and cut them down by 22″, my plan is to use them for the chicken coop which I will build this summer.

Rear of Barn, second story door in place as siding continues.

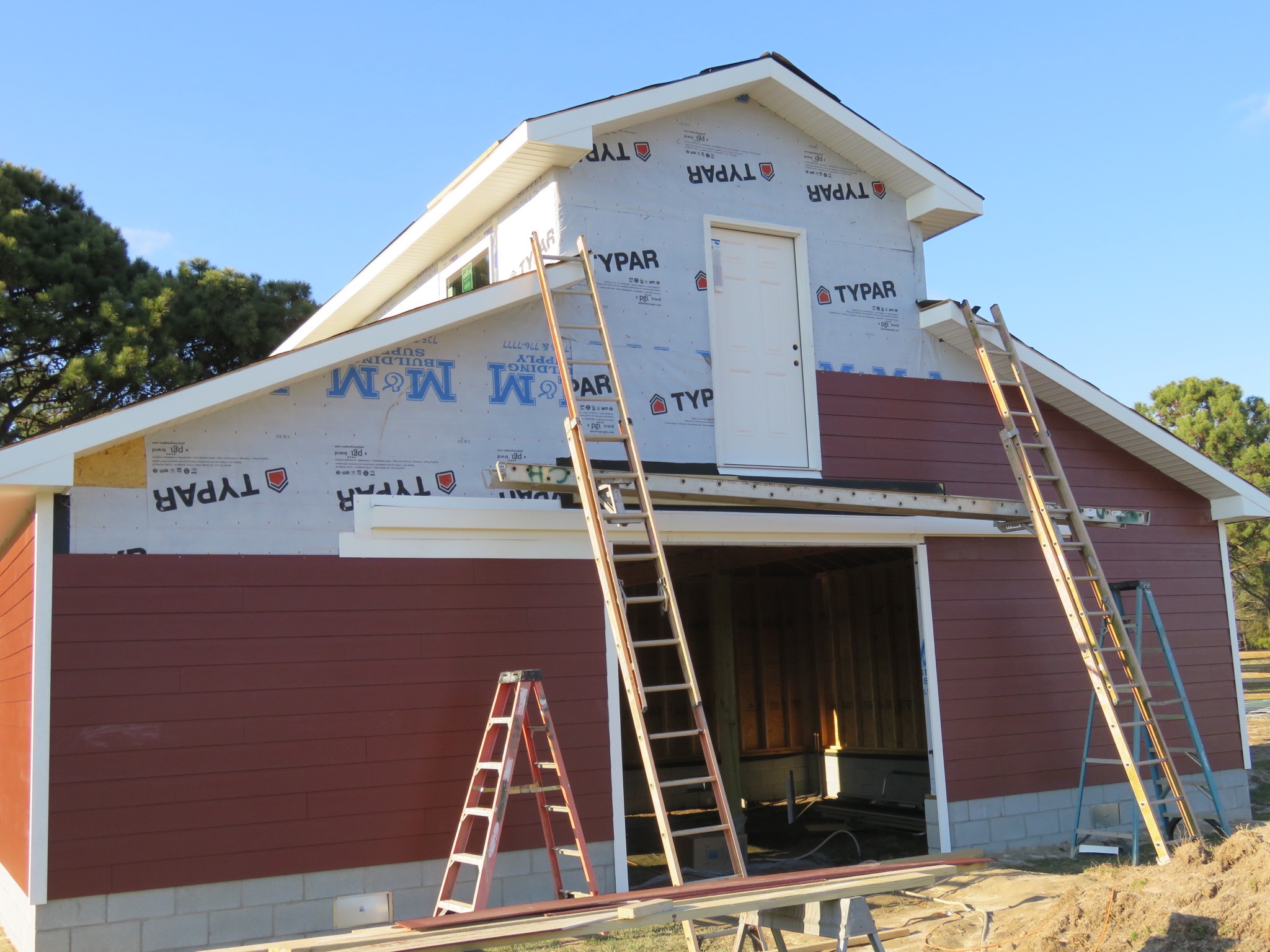

Rear of Barn, second story door in place as siding continues.(2/26/16)
Work continues on a very windy day (2/25/16)
Work continues on a very windy day (2/25/16)

IMG_5453

IMG_5455
Chad, Allen the roofer and his helper setting the base and next section
IMG_5457

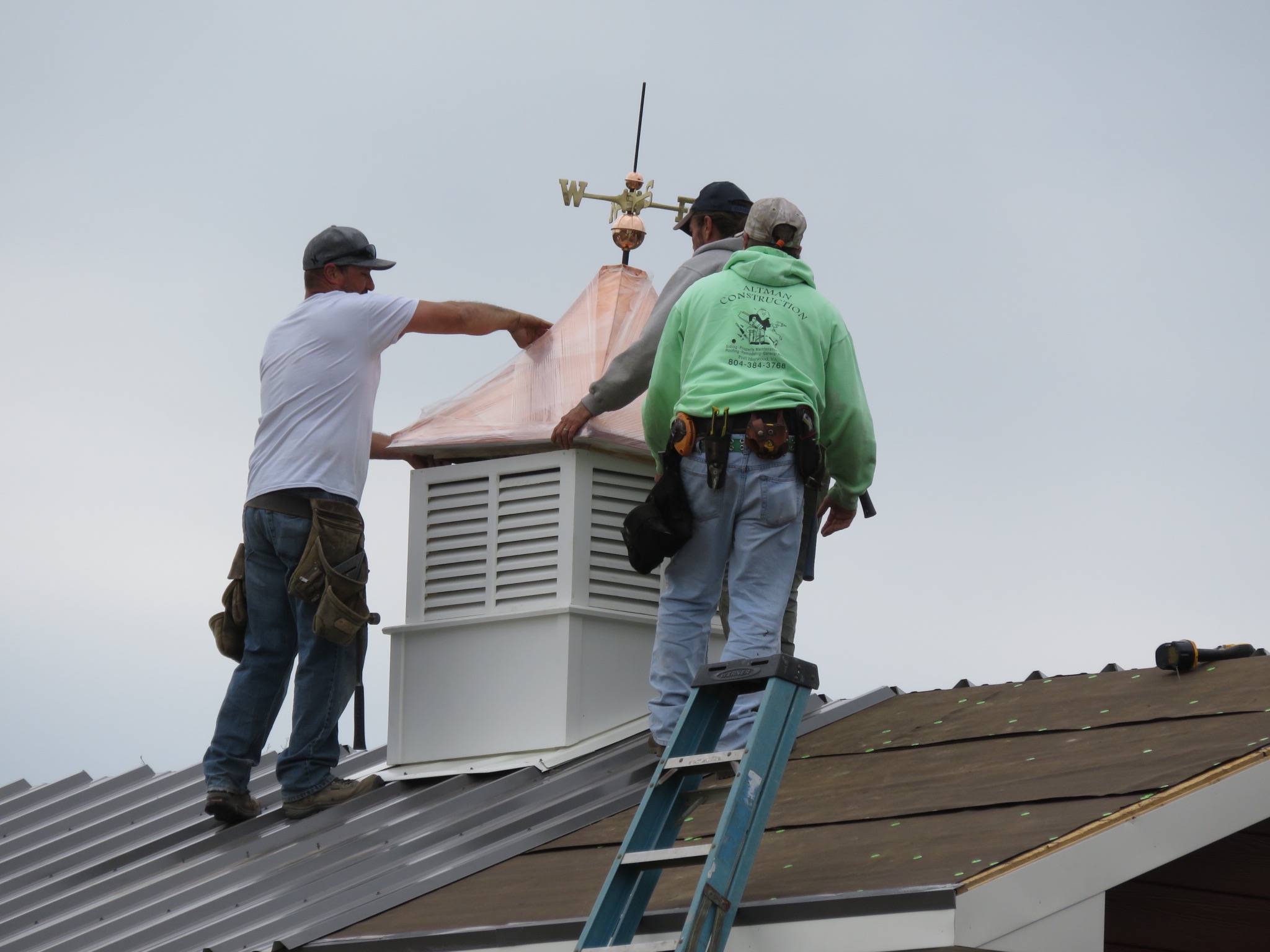

The top of the Cupola is set in place
IMG_5461
The finished Cupola withe the Weather Vane installed.

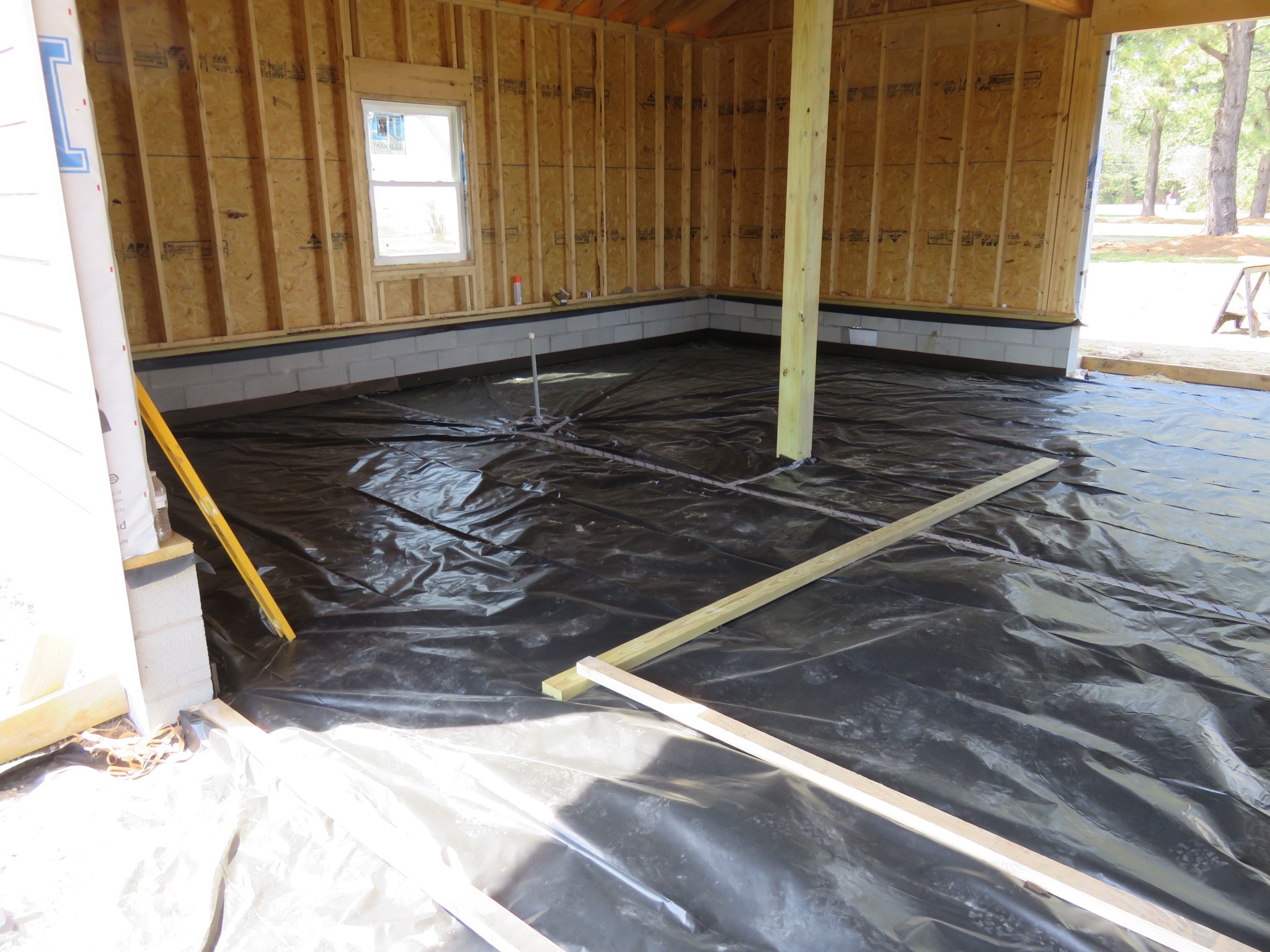

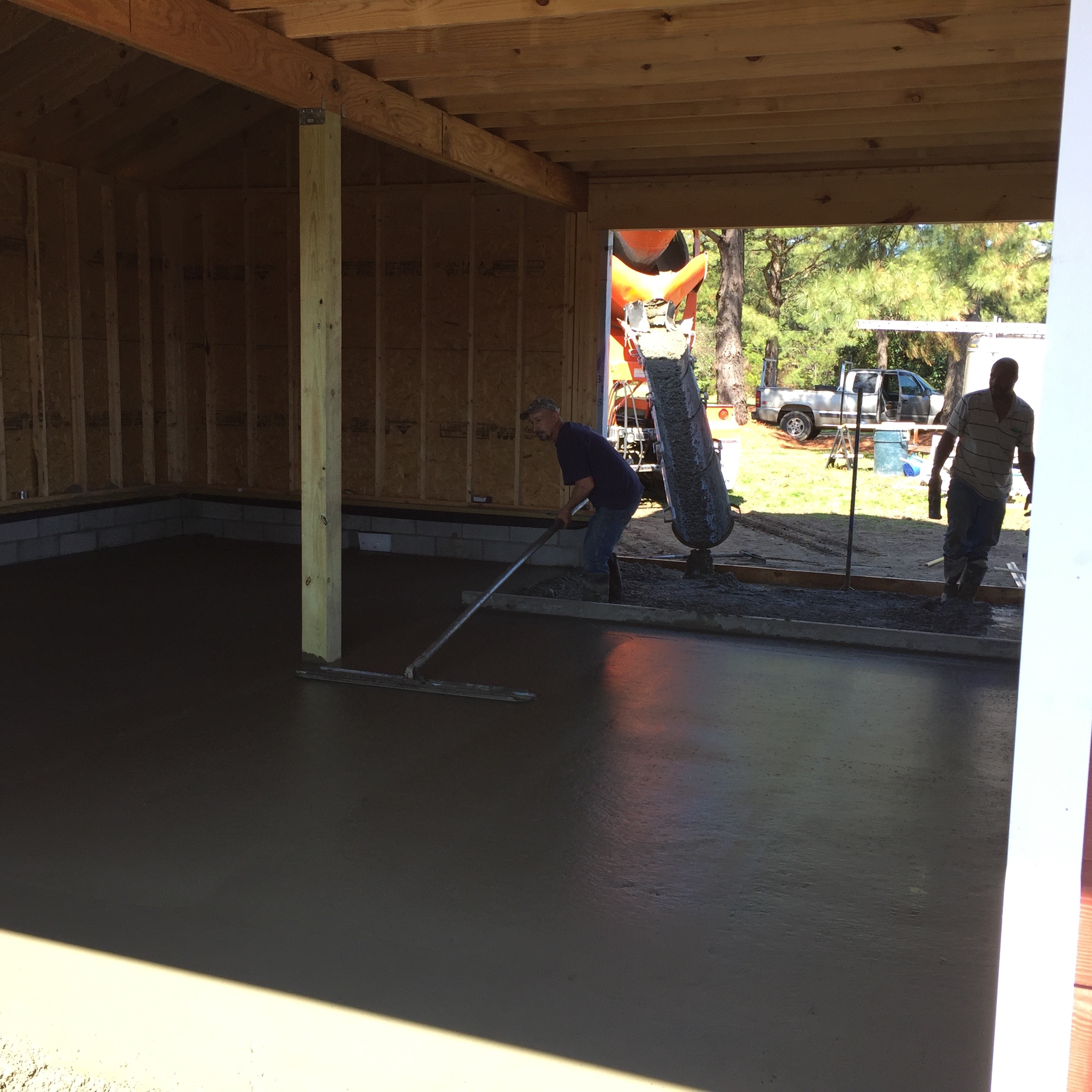

Cupola being installed on the barn (3/11/16) The next step is to pour the concrete floor in the barn.

Barn ready for the concrete pour.
Barn ready for the concrete pour.
Barn with siding complete
Barn with siding complete

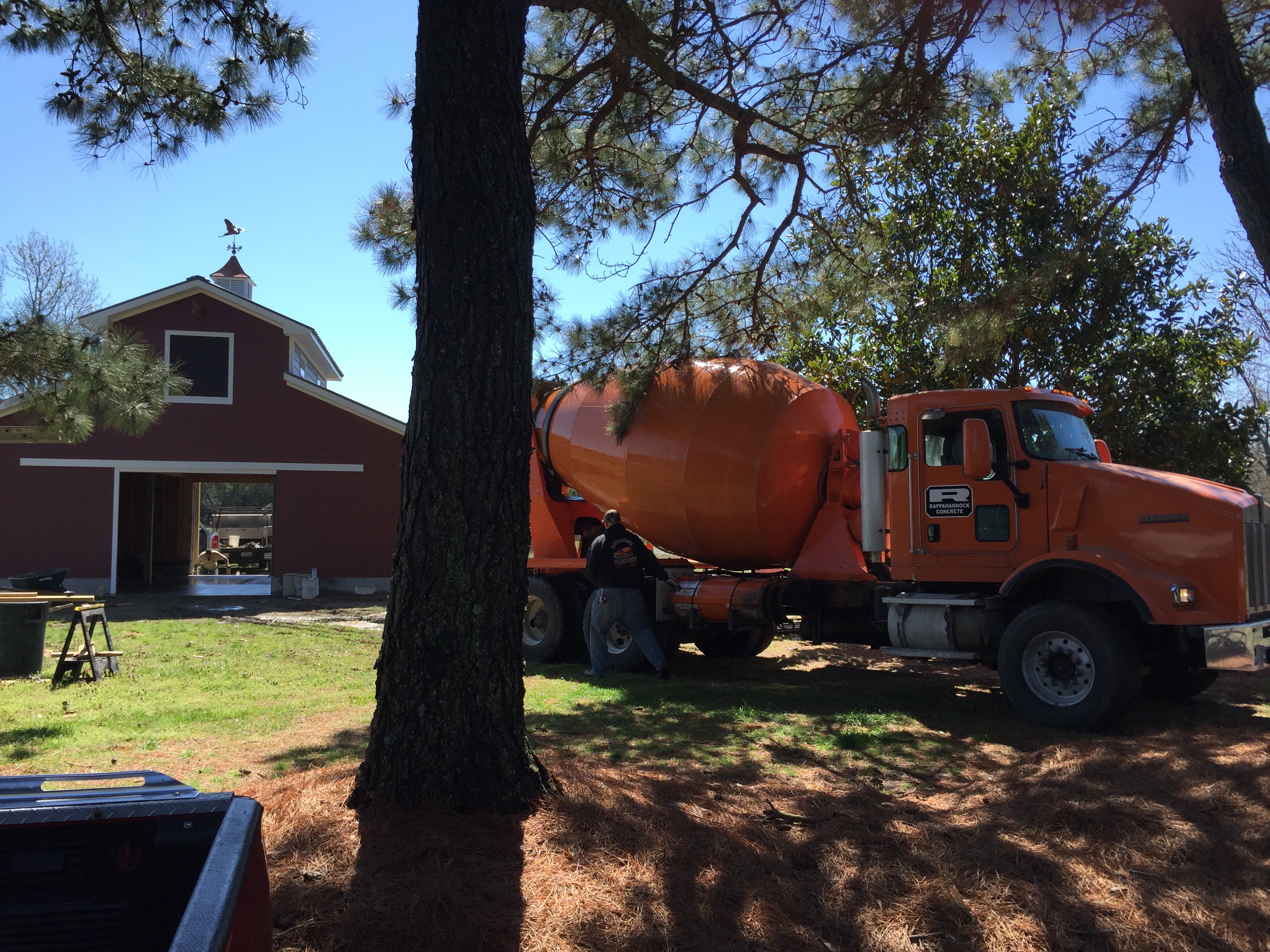

The roofer working on the final section, its been difficult with the 13MPH winds out of the southwest gusting to IMG_378827MPH holding a sheet of steel is like being launched off an aircraft carrier. Today March 28, 2016 the concrete is being

Concrete truck
Concrete truck

poured for the

Screening the concrete
Screening the concrete

slab in the barn.  Of course it rained for 2 days meaning the the truck will tear up the yard around

Delivery problems
April 5, 2016 – Delivery problems

the barn. Well here we are and it April 5, 2016 and were still waiting on a delivery of Hardi-board for the barn doors.  The doors are complete and hanging on the barn however we can not proceed due to damage in shipment for the second time.  The replacements are due with tomorrow or Friday.  The plan “B” is to scrap the hard-board and use MDO plywood and paint with a match to the siding.

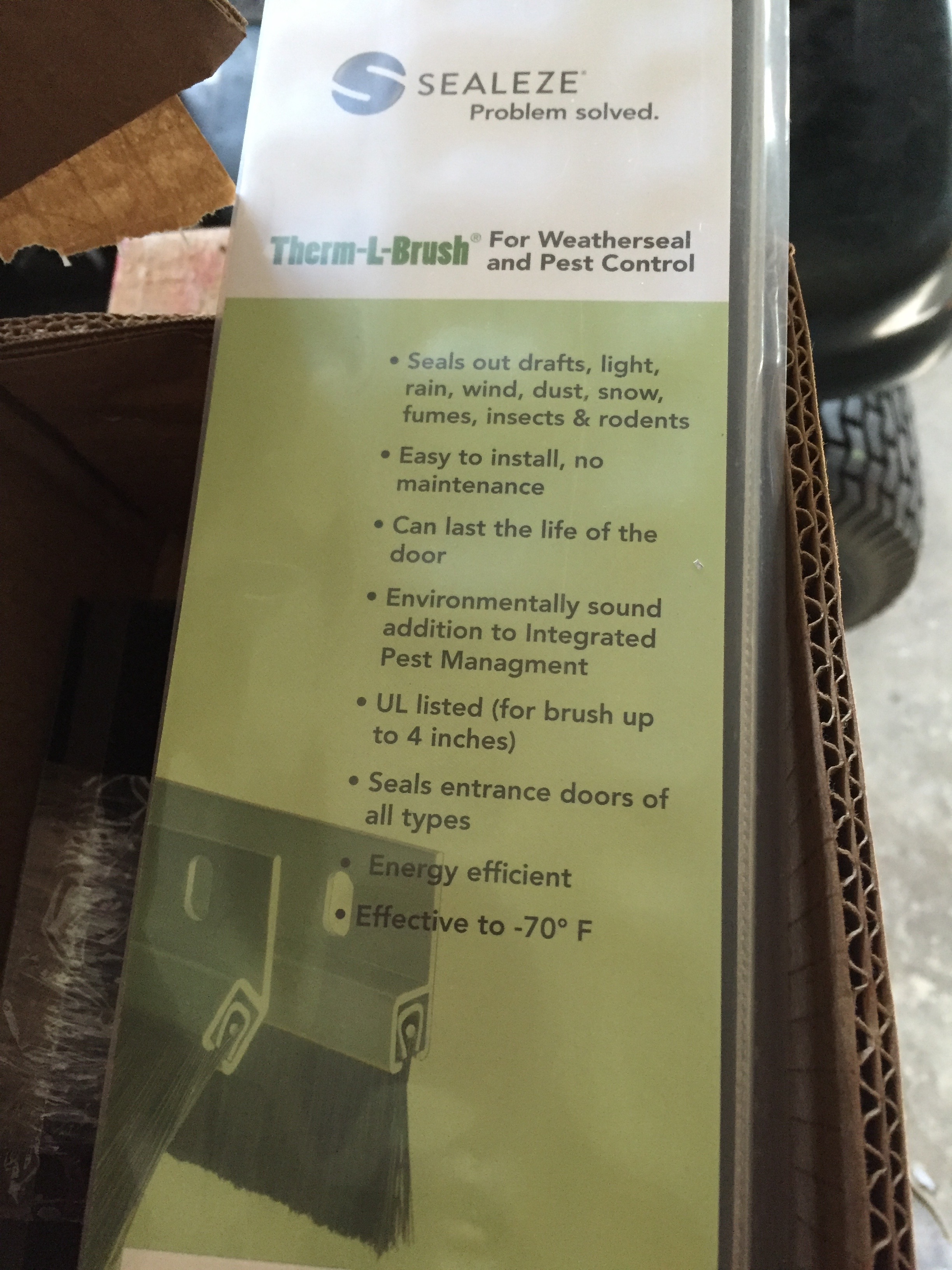

Sealeze like a poly paintbrush.
Sealeze like a poly paintbrush.

Weather stripping arrived today from Sealeze.  The strips will be applied to all sides of the doorway and the bottom of the door to create more of an weather protected environment.

Mean while Pat has a project of her own going. Well the saga continues, the door windows are installed and the aluminum is on the inside opening but still no Hardi-Board.  I will be stopping at M&M next week to have a chat with the owner.  With plans to renovate the old cottage and an estimated material cost of well in excess of $100K being treated like a second class customer is totally unacceptable!IMG_3832

Where every Buoy tells a story…
